Audit snapshot

What is the purpose of the MPR?

The MPR is an annual review of the Department of Defence’s major defence equipment acquisitions, undertaken at the request of the Parliament’s Joint Committee of Public Accounts and Audit (JCPAA).

Its purpose is to provide information and assurance to the Parliament on the performance of selected acquisitions as at 30 June 2021.

This year, it includes 21 major projects.

This is the 14th MPR since its commencement in 2007–08.

What did we find?

The Auditor–General concluded that:

Based on the procedures I have performed and the evidence I have obtained, nothing has come to my attention that causes me to believe that the information in the 21 Project Data Summary Sheets in Part 3 (PDSSs) and the Statement by the Secretary of Defence, excluding the forecast information, has not been prepared in all material respects in accordance with the 2020–21 Major Projects Report Guidelines, as endorsed by the JCPAA.

What is reviewed?

The Department of Defence prepares Project Data Summary Sheets (PDSS) on selected major defence equipment acquisition projects in accordance with guidelines endorsed by the JCPAA.

The ANAO reviews the information in the PDSSs in accordance with the ANAO Auditing Standards specified by the Auditor-General under the Auditor-General Act 1997.

The PDSSs cover:

  1. Background and government approvals
  2. Financial performance
  3. Schedule performance
  4. Delivery against agreed scope
  1. Risks and issues
  2. Lessons learned by the project
  3. Management accountability for the project

$58bn

was the value of the 21 Defence Major Projects as at 30 June 2021.

5 of 21

Defence Major Projects experienced in-year schedule slippage.

97%

was the expected delivery against agreed scope across the Major Projects as at 30 June 2021 — with 6 projects reporting that some elements of capability delivery are under threat or unlikely to be met.

Due to the complexity of material and the multiple sources of information for the 2020–21 Major Projects Report, we are unable to represent the entire document in HTML. You can download the full report in PDF or view selected sections in HTML below. PDF files for individual Project Data Summary Sheets (PDSS) are also available for download.

!Part 1. ANAO Review and Analysis

.

Summary

Background

1. The Department of Defence’s (Defence) Capability Acquisition and Sustainment Group (CASG) manages the process of bringing new specialist military equipment into service for the Australian Defence Force (ADF). As at 30 June 2021, CASG was managing 174 active major and minor capital equipment projects worth $121.6 billion1, with an in-year budget of $8.6 billion.2 Defence capitalised some $9.0 billion from these projects in 2020–21.3

2. The Major Projects Report (MPR) comprises: Defence information and commentary on a selection of its major projects (the Major Projects); and assurance and analysis of that information by the Australian National Audit Office (ANAO). This is the fourteenth annual MPR.

3. Major Projects are selected for inclusion in the MPR based on criteria endorsed by the Parliament’s Joint Committee of Public Accounts and Audit (JCPAA).4 The projects represent a selection of the most significant major projects managed by CASG.

4. The total approved budget for the 21 Major Projects included in this report is approximately $58.0 billion, covering 48 per cent of the total budget of active major and minor capital equipment projects of $121.6 billion.

Selected projects

5. The Major Projects selected for review and their government approved budgets as at 30 June 2021 are listed in Table 1, on p.4. They comprise six AIR projects, eight SEA projects, five LAND projects and two joint (JP) projects.

Table 1: 2020–21 MPR — selected projects and approved budgets at 30 June 20211

Project Number (Defence Capability Plan)

Project Name (on Defence advice)

Abbreviation (on Defence advice)

Approved Budget $m

AIR 6000 Phase 2A/2B

New Air Combat Capability

Joint Strike Fighter2

15,630.7

SEA 5000 Phase 1

Future Frigates

Future Frigates2

6046.9

SEA 1000 Phase 1B

Future Submarines Design Acquisition

Future Subs2

5818.2

LAND 400 Phase 2

Combat Reconnaissance Vehicles

Combat Recon. Vehicles2

5655.4

AIR 9000 Phase 2/4/6

Multi-Role Helicopter

MRH90 Helicopters2

3770.0

SEA 1180 Phase 1

Offshore Patrol Vessel

Offshore Patrol Vessel2

3669.6

LAND 121 Phase 3B

Medium Heavy Capability, Field Vehicles, Modules and Trailers

Overlander Medium/Heavy2

3397.8

AIR 7000 Phase 1B

MQ-4C Triton Remotely Piloted Aircraft System

MQ-4C Triton

1953.4

LAND 121 Phase 4

Protected Mobility Vehicle – Light (PMV-L)

Hawkei2

1952.9

AIR 8000 Phase 2

Battlefield Airlift – Caribou Replacement

Light Tactical Fixed Wing2,3

1426.1

LAND 19 Phase 7B

Short Range Ground Based Air Defence

SRGB Air Defence1

1201.0

AIR 2025 Phase 6

Jindalee Operational Radar Network

JORN Upgrade1,2

1128.6

SEA 1654 Phase 3

Maritime Operational Support Capability

Repl Replenishment Ships

1082.6

AIR 5431 Phase 3

Civil Military Air Management System

CMATS2

974.5

LAND 200 Tranche 2

Battlefield Command System

Battlefield Command System2

962.3

JP 2072 Phase 2B

Battlespace Communications System Phase 2B

Battle Comm. Sys. (Land) 2B

942.2

SEA 1439 Phase 5B2

Collins Class Communications and Electronic Warfare Improvement Program

Collins Comms and EW2

608.7

SEA 3036 Phase 1

Pacific Patrol Boat Replacement

Pacific Patrol Boat Repl

501.4

SEA 1442 Phase 4

Maritime Communications Modernisation

Maritime Comms2

434.1

SEA 1448 Phase 4B

ANZAC Air Search Radar Replacement

ANZAC Air Search Radar Repl2

429.1

JP 2008 Phase 5A

Indian Ocean Region UHF SATCOM

UHF SATCOM

421.3

Total

21

58,006.8

Note 1: LAND 19 Phase 7B Short Range Ground Based Air Defence and AIR 2025 Phase 6 Jindalee Operational Radar Network are included in the MPR Program for the first time in 2020–21.

Note 2: These projects have been the subject of individual performance audits. See Table 8, on pp.42–45, for more information.

Note 3: Light Tactical Fixed Wing was previously called Battlefield Airlifter. For further discussion see the Light Tactical Fixed Wing PDSS in Part 3.

Source: The PDSSs in Part 3 of this report.

Rationale for undertaking the review

6. Defence’s major defence equipment acquisition projects continue to be the subject of parliamentary and public interest. This is due to their high cost and contribution to national security, the challenges involved in completing them within the specified budget and schedule, and to the required capability, and their contribution to industrial and employment policy objectives.

7. The JCPAA has stated that the objective of the MPR is ‘to improve the accountability and transparency of Defence acquisitions for the benefit of Parliament and other stakeholders.’5

Conduct of the review

8. Defence prepares information for ANAO review in accordance with guidelines endorsed annually by the JCPAA (included in Part 4 of this report).6 The status of the Major Projects selected for review is reported in the Statement by the Secretary of Defence (included in Part 3 of this report) and a Project Data Summary Sheet (PDSS) prepared by Defence for each of the Major Projects (included in Part 3 of this report).

9. The ANAO has reviewed each of the PDSSs prepared by Defence as a ‘priority assurance review’ under subsection 19A(5) of the Auditor-General Act 1997 (the Act), allowing the ANAO full access to the information gathering powers under the Act.

10. The ANAO’s review provides limited assurance7 and was undertaken in accordance with the applicable auditing standards. The ANAO’s review included an assessment of Defence’s systems and controls, including the governance and oversight in place, to ensure appropriate project management. The ANAO also sought representations and confirmation from Defence senior management and industry (through Defence) in relation to the status of the selected Major Projects.

11. The objective of this ANAO assurance engagement and the ANAO review procedures is to provide a basis for independent assurance by the Auditor-General over the status of the Major Projects selected for review. The Auditor-General’s summary conclusion is set out below. The full conclusion is found in the Auditor-General’s Independent Assurance Report in Part 3 of this report.

12. Certain forecast information found in the PDSSs is excluded from the scope of the ANAO’s review, such as forecast dates, expected capability delivery performance and future risks.8 Accordingly, the Auditor-General’s Independent Assurance Report does not provide any assurance in relation to this information. However, material inconsistencies identified in relation to this information are considered in forming the Auditor-General’s conclusion. These exclusions to the scope of the review are due to a lack of Defence systems from which to provide complete and accurate evidence9 in a sufficiently timely manner to facilitate the review. This has been an area of focus of the JCPAA over a number of years10, and it is intended that all components of the PDSSs will eventually be included within the scope of the ANAO’s review.

13. Separate to the formal assurance review, the ANAO has also undertaken an analysis of key elements of the PDSSs — including cost, schedule, progress towards delivery of required capability, and risks and issues. Longitudinal analysis across these key elements of projects has also been undertaken by the ANAO.

14. Defence also provides additional insights and context in: its commentary and analysis contained in Part 2 of the MPR; and information on significant events occurring post 30 June 2021 in the Statement by the Secretary of Defence contained in Part 3 of the MPR. This commentary and analysis is not included in the scope of the ANAO’s review.

Overall outcomes of the review

Auditor-General’s summary conclusion

15. The Auditor-General has concluded in the Independent Assurance Report for 202021 that ‘nothing has come to my attention that causes me to believe that the information in the 21 Project Data Summary Sheets in Part 3 (PDSSs) and the Statement by the Secretary of Defence, excluding the forecast information, has not been prepared in all material respects in accordance with the 2020–21 Major Projects Report Guidelines (the Guidelines), as endorsed by the Joint Committee of Public Accounts and Audit.’

Statement by the Secretary of Defence

16. The Statement by the Secretary of Defence was signed on 2 December 2021. The Secretary’s statement provides his opinion that the PDSSs for the 21 selected projects ‘comply in all material respects with the Guidelines and reflect the status of the projects as at 30 June 2021’.

17. In addition, the Statement by the Secretary of Defence details significant events occurring post 30 June 2021, which materially impact the projects included in the report, and which should be read in conjunction with the individual PDSSs. The Statement includes information on: Joint Strike Fighter, Future Frigates, Future Subs, MRH90 Helicopters, Offshore Patrol Vessel, Repl Replenishment Ships, Battle Comm. Sys. (Land) 2B, Maritime Comms, ANZAC Air Search Radar Repl and UHF SATCOM.11

Summary of key observations from the ANAO’s review

18. The ANAO’s review (found in Part 1 of this report) includes Defence’s project management and reporting arrangements contributing to the overall governance of the Major Projects. A summary of key observations is provided below.

Status of JCPAA recommendations and requests

  • Following JCPAA recommendations made in May 2014 and May 201612, Defence is yet to implement a system of materiel capability delivery performance/scope reporting, with a robust methodology applicable to materiel acquisition (see paragraphs 2.63 to 2.68).
  • Following a JCPAA recommendation made in September 201813, Defence advised the Committee in May 2020 that Predict! was the mandated risk management system.14 Defence advised the ANAO in October 2021 that Defence’s policy was updated in August 2021 to reflect that risks must be recorded in Predict!, although this is yet to be applied consistently across all projects (see paragraphs 1.76 to 1.80).
  • Following a JCPAA request made in 201815 ‘on how Defence major project cost variations and the costs of retaining project staff over time might be reported annually in future Major Projects Reports’, Defence advised that it is not yet in a position to provide the staff cost component of projects and its systems are not capable of calculating the cost of retaining project staff over time (see paragraphs 1.64 to 1.67).

Status of Auditor-General report recommendations

  • Auditor-General Report No.34 2020–21 Implementation of ANAO and Parliamentary Committee Recommendations — Department of Defence tabled in April 2021 and included an assessment of four recommendations relevant to the MPR.16 Of these, one was assessed as implemented, one was largely implemented, and two were not implemented.
  • In July 2020 Defence closed both recommendations from Auditor-General Report No.31 2018–19 Defence’s Management of its Projects of Concern. The ANAO assessed these recommendations as not implemented (see paragraphs 1.19 to 1.21).17
  • Defence closed Recommendation No.1 from Auditor-General Report No.3 2019–20 Defence’s Quarterly Performance Report on Acquisition and Sustainment in March 2020, and this was considered in Auditor-General Report No.19 2019–20 Major Projects Report.18 The ANAO assessed this recommendation as implemented (see paragraphs 1.27 to 1.28).19
  • Recommendation No.1 from Auditor-General Report No.40 2018–19 Modernising Army Command and Control — the Land 200 Program was assessed as largely implemented.20
  • Other relevant ANAO audits tabled in 2020–21 include: Auditor-General Report No.18 2020–21 Defence’s Procurement of Combat Reconnaissance Vehicles (LAND 400 Phase 2) and Auditor-General Report No.12 2020–21 Defence’s Procurement of Offshore Patrol Vessels SEA 1180 Phase 1. These audits included recommendations for improvement in Defence Independent Assurance Review processes. The Defence Audit and Risk Committee has accepted closure of the two recommendations from Auditor-General Report No.12 2020–21 Defence’s Procurement of Offshore Patrol Vessels SEA 1180 Phase 1. Reporting is yet to be provided to the Committee on the recommendation in Auditor-General Report No.18 of 2020–21 Defence’s Procurement of Combat Reconnaissance Vehicles (LAND 400 Phase 2) (see paragraphs 1.14 to 1.17).

Defence acquisition governance

19. In the course of its review of the PDSSs, the ANAO considered:

  • Defence’s system for reporting on the status of acquisition projects through the Independent Assurance Review (IAR) process. Fifteen of the 21 projects included in this report had an IAR conducted during 2020–2121 (see paragraphs 1.11 to 1.13).
  • Defence’s approach to entry and exit from the Projects of Interest and Projects of Concern lists (see paragraphs 1.18 to 1.23).
  • The reporting provided to senior stakeholders within government and Defence with insight into the delivery of capability to the Australian Defence Force. The ANAO observed a gap in reporting activity (see paragraphs 1.26 to 1.33).
  • The importance of capturing government decisions in internal Defence documentation and ensuring that Materiel Acquisition Agreements are appropriately aligned with these decisions (see paragraphs 1.36 to 1.42).
  • Defence’s implementation of the Smart Buyer Framework to support strategic decision making in the acquisition of major projects. The framework was not utilised at the Second Pass government approval stage for projects in the current MPR (see paragraphs 1.43 to 1.44).
  • Implementation of new business systems to report on the status of acquisition projects (see paragraphs 1.45 to 1.48).
  • Projects’ use of contingency funds (see paragraphs 1.56 to 1.60). Two projects in the MPR, MRH90 Helicopters and Battle Comm. Sys. (Land) 2B, committed contingency funds in 2020–21. The MRH90 Helicopters project committed $34.4 million of contingency funds to manage supportability and performance risks. The Battle Comm. Sys. (Land) 2B project used $30.3 million of contingency funds to address delayed delivery and refinement of specifications.
  • The status of CASG’s Risk Management Reform Program (initiated by the Deputy Secretary CASG in 2017) and establishment of the CASG Risk Management Framework (see paragraphs 1.68 to 1.80).
  • A number of projects had not fully met the requirements of Defence’s Project Risk Management Manual Version 2.5 (PRMM V2.5) in relation to contingency allocation (see paragraph 1.60) and risk management (see paragraph 1.74).
  • Defence updated its policy on Lessons Learned in May 2020 but is yet to fully implement the policy, including compliance monitoring arrangements (see paragraphs 1.81 to 1.83).
  • Defence has not defined in its internal policies and procedures the terms ‘caveat’ or ‘deficiency’ relating to the declaration of significant capability milestones. The ANAO has continued to observe the use of these terms by Defence to represent exceptions to the achievement of significant milestones (see paragraphs 1.84 to 1.86).

ANAO analysis of project performance

20. In addition to its limited assurance review, the ANAO has undertaken an analysis of key elements of the Defence PDSSs — relating to cost, schedule, progress towards delivery of required capability, and risks and issues. The ANAO has also undertaken longitudinal analysis across these key elements of projects.

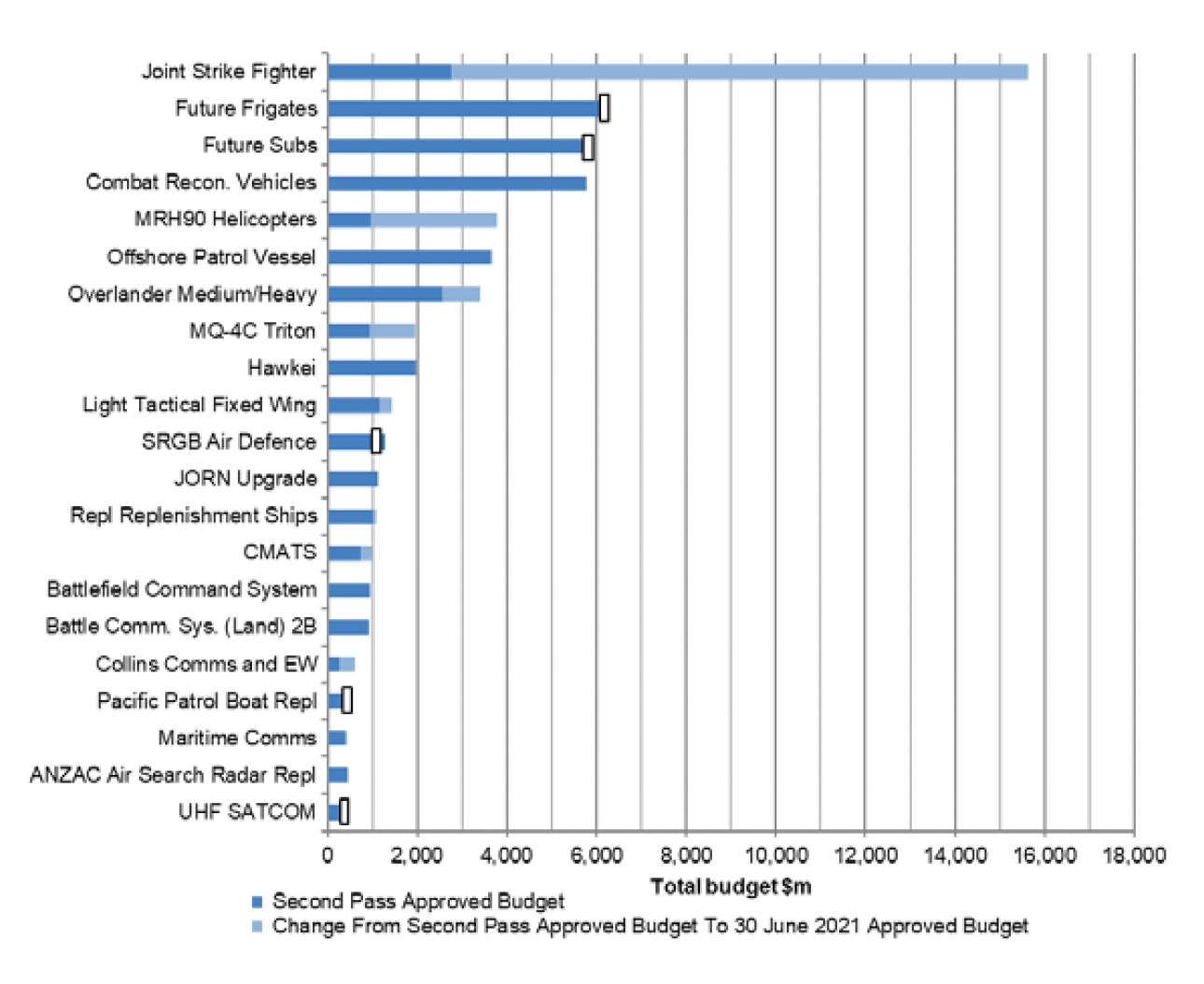

Cost

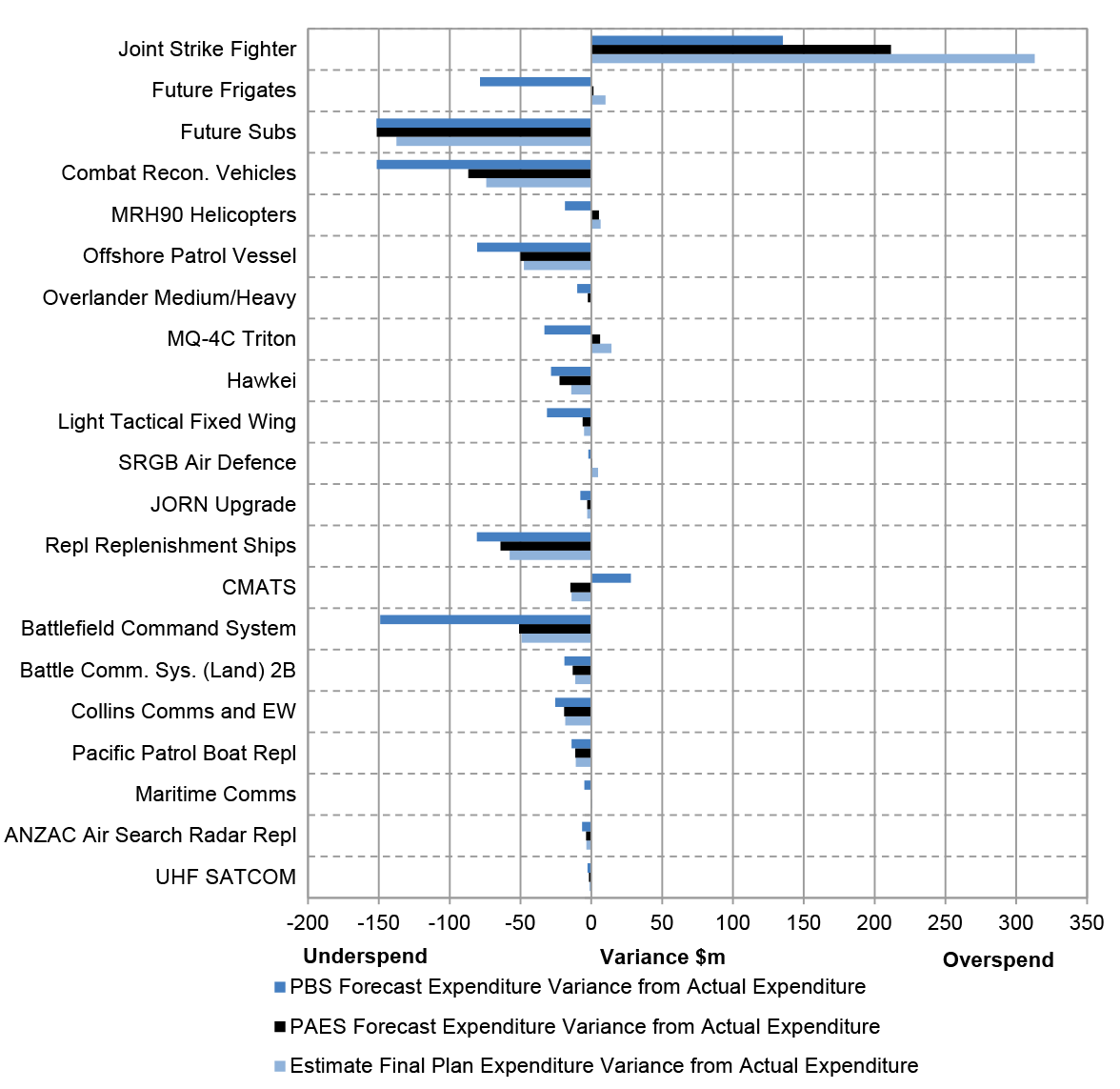

21. Cost management is an ongoing process in Defence’s administration of the Major Projects. While all projects reported that they could continue to operate within the total approved budget of $58.0 billion, the MRH90 Helicopters and Battle Comm. Sys. (Land) 2B projects were required to draw upon contingency funds to complete project activities.

22. The total approved budget for Major Projects included in this MPR has increased by $18.3 billion (33 per cent) since initial Second Pass Approval by government.

23. Budget variations greater than $500 million are detailed in Table 2, on p.11.22

24. As the MPR predominantly focuses on the approved capital budget for acquisition, the ongoing costs of Project Offices23, training, replacement capability, etc., are not reported here.

Table 2: Budget variations over $500 million — post initial Second Pass approval by variation type1,2

Project

Variation

Explanation

Year

Amount $bn

Scope Increases

13.9

MRH90 Helicopters

34 additional aircraft at Phase 4/6 Second Pass Approval

2005–06

2.3

Joint Strike Fighter

58 additional aircraft at Stage 2 Second Pass Approval

2013–14

10.5

MQ-4C Triton

Second Pass Approval – Tranche 2 (one additional aircraft), Tranche 3 (one additional aircraft) and Tranche 4 (sustainment funding for first 7 years).

2019–20

2020–21

1.1

Real Cost Increases

0.7

Overlander Medium/Heavy

Project supplementation3 ($684.2m) and additional vehicles, trailers and equipment ($28.0m) at Revised Second Pass Approval

2013–14

0.7

Other budget movements

0.7

Other

Scope increase/budget transfers (net)

Other scope changes and transfers

Various

0.7

Price Indexation – materials and labour (net) (to July 2010)4

1.0

Exchange Variation – foreign exchange (net) (to 30 June 2021)

1.9

Total

18.2 5

Note 1: For the variations related to all projects and their value, refer to Table 8 on pp.42–45 of this report. For the breakdown of in–year variation, refer to Table 9 on p.47 of this report.

Note 2: For projects with multiple Second Pass Approvals, this table shows variations from the initial approval.

Note 3: Defence has advised that ‘project supplementation’ is a unique term used to describe the approvals history of this project as follows: ‘The original amount of $2549.2, was the Government decision to split Phase 3 into Phase 3A and 3B. In 2011, Government approved Second Pass approval of Phase 3A and the ‘Interim Pass’ Government approval for Phase 3B. The decision to grant Phase 3B ‘Interim Pass’ was to allow greater bargaining power for Defence while negotiating Phase 3A. Phase 3B was always going to return to Government for formal Second Pass approval, which occurred in July 2013, once contract negotiations were complete.’

Note 4: Prior to 1 July 2010, projects were periodically supplemented for price indexation, whereas the allocation for price indexation is now provided for on an out-turned basis at Second Pass Approval.

Note 5: Figures do not add precisely due to rounding. The total is $18.3bn.

Source: ANAO analysis of the 2020–21 PDSSs.

Schedule

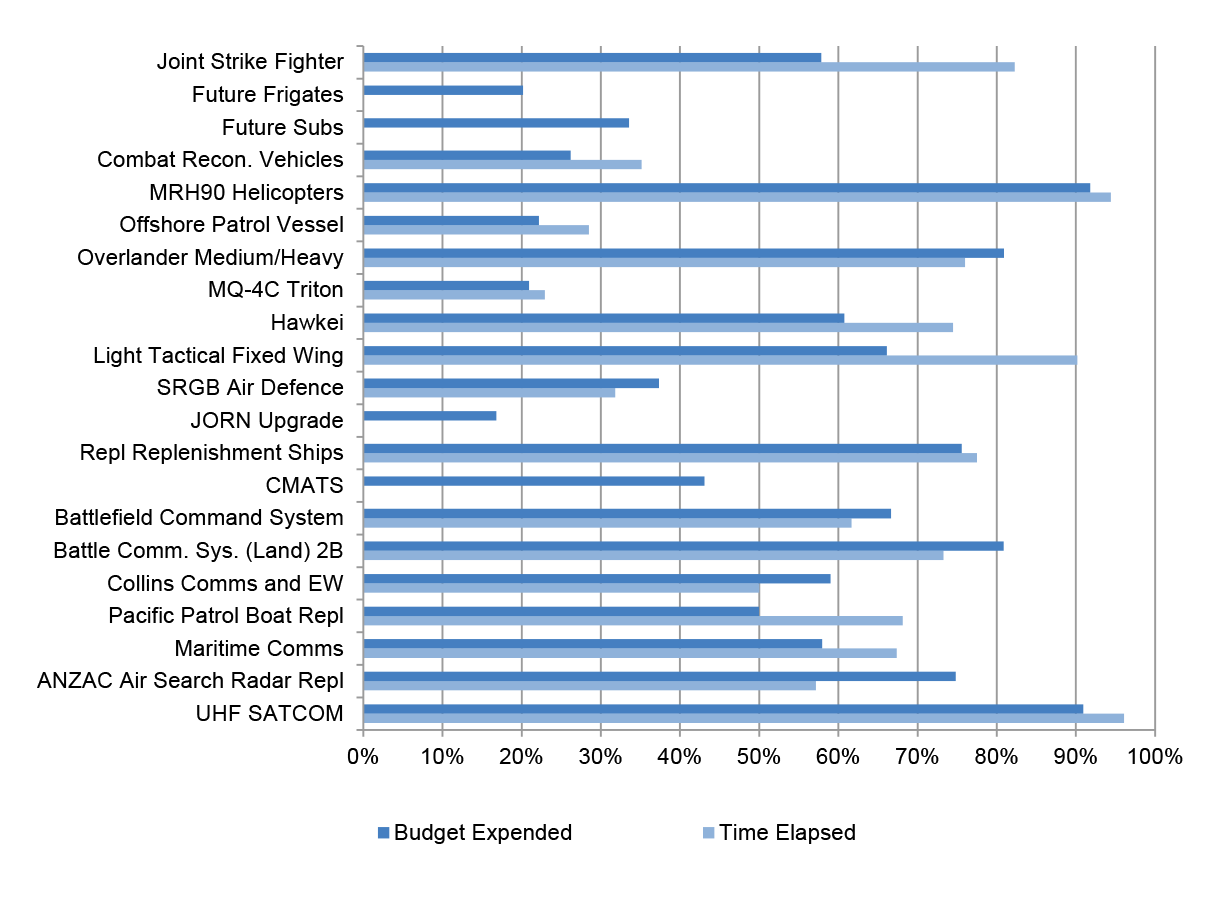

25. Delivering Major Projects on schedule continues to present challenges for Defence, affecting when the capability is made available for operational release and deployment by the Australian Defence Force, as well as the cost of delivery.

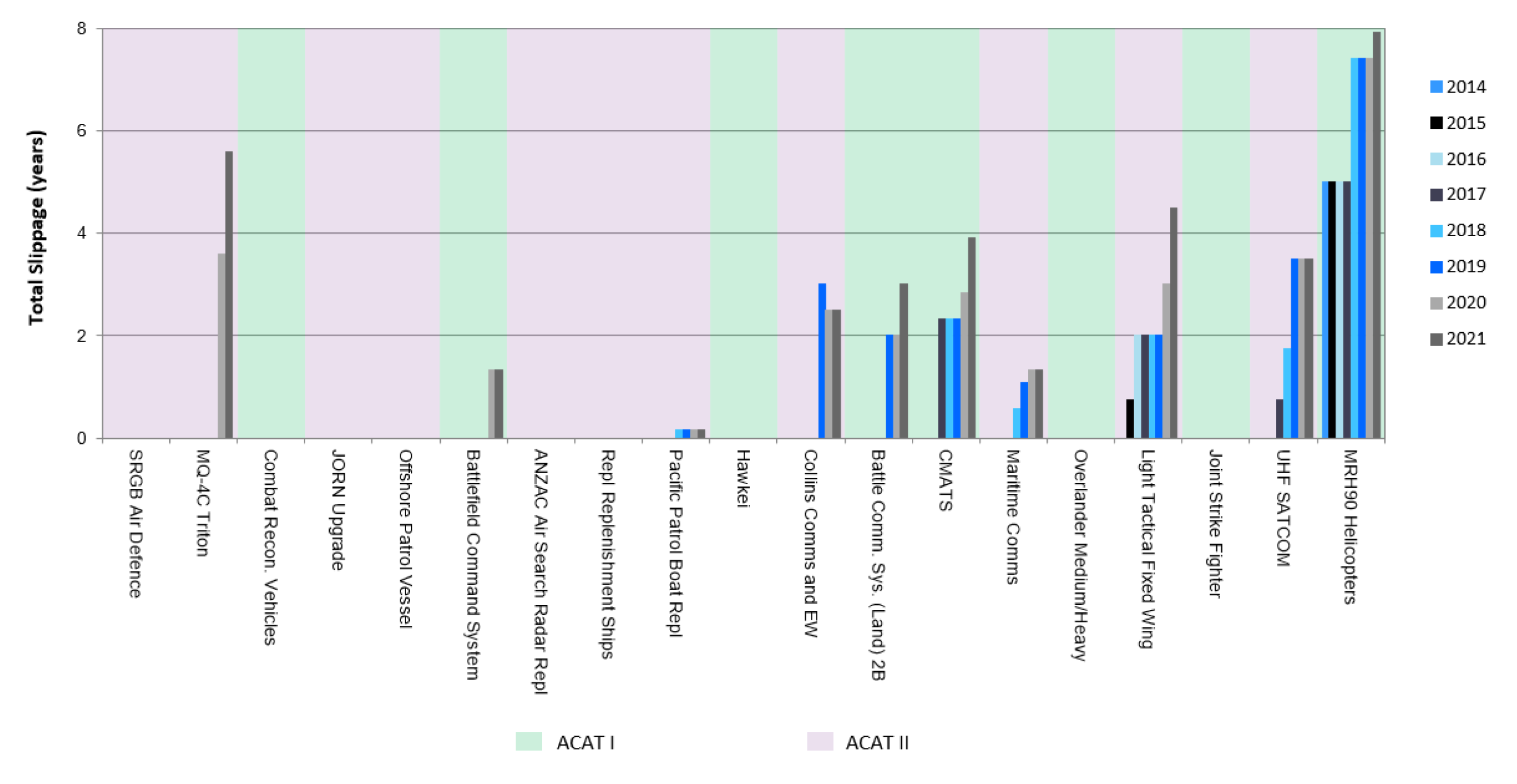

26. Total schedule slippage24 for the Major Projects, as at 30 June 2021, was 405 months when compared to the initial schedule. This represents a 23 per cent increase since Second Pass approval.

27. Across MPR projects that have experienced slippage — comprising 10 of the 19 projects with approved dates for Final Operational Capability (FOC)25 — the average slippage is 40 months (3.38 years).

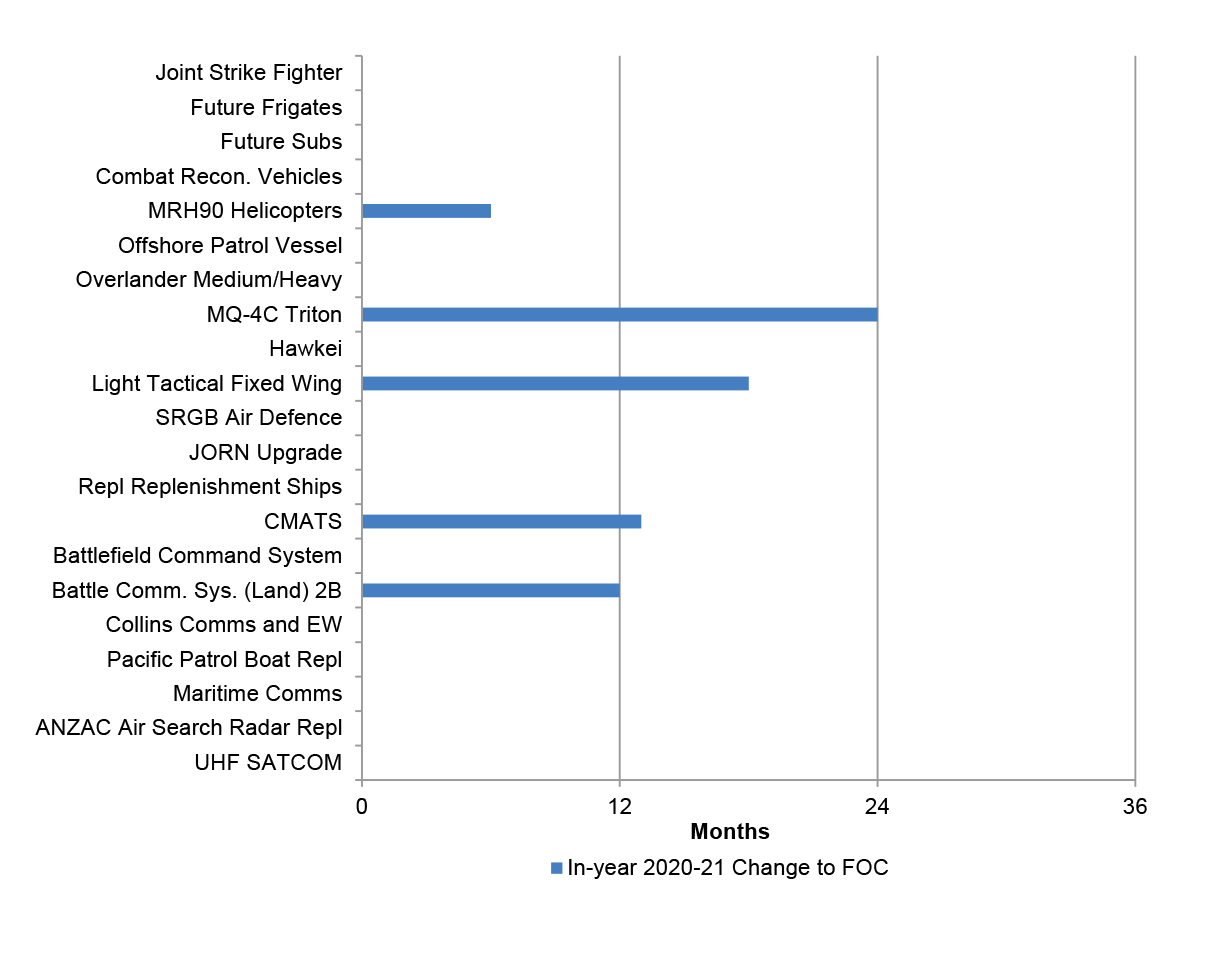

28. Table 3, on p.13, includes details of in-year and total schedule slippage by project. The table shows an increase of 73 months of in-year slippage during 2020–21.

29. The total slippage of 405 months in 2020–21 is 102 months lower than the total in 2019‍–‍20 of 507 months. This is due to:

  • the exclusion of projects which have exited the MPR (AWD Ships, P-8A Poseidon, Growler, and Collins R&S), removing 175 months of slippage from the total reported in 2019–20 (see Table 4); and
  • the increase of 73 months of in-year slippage described above.

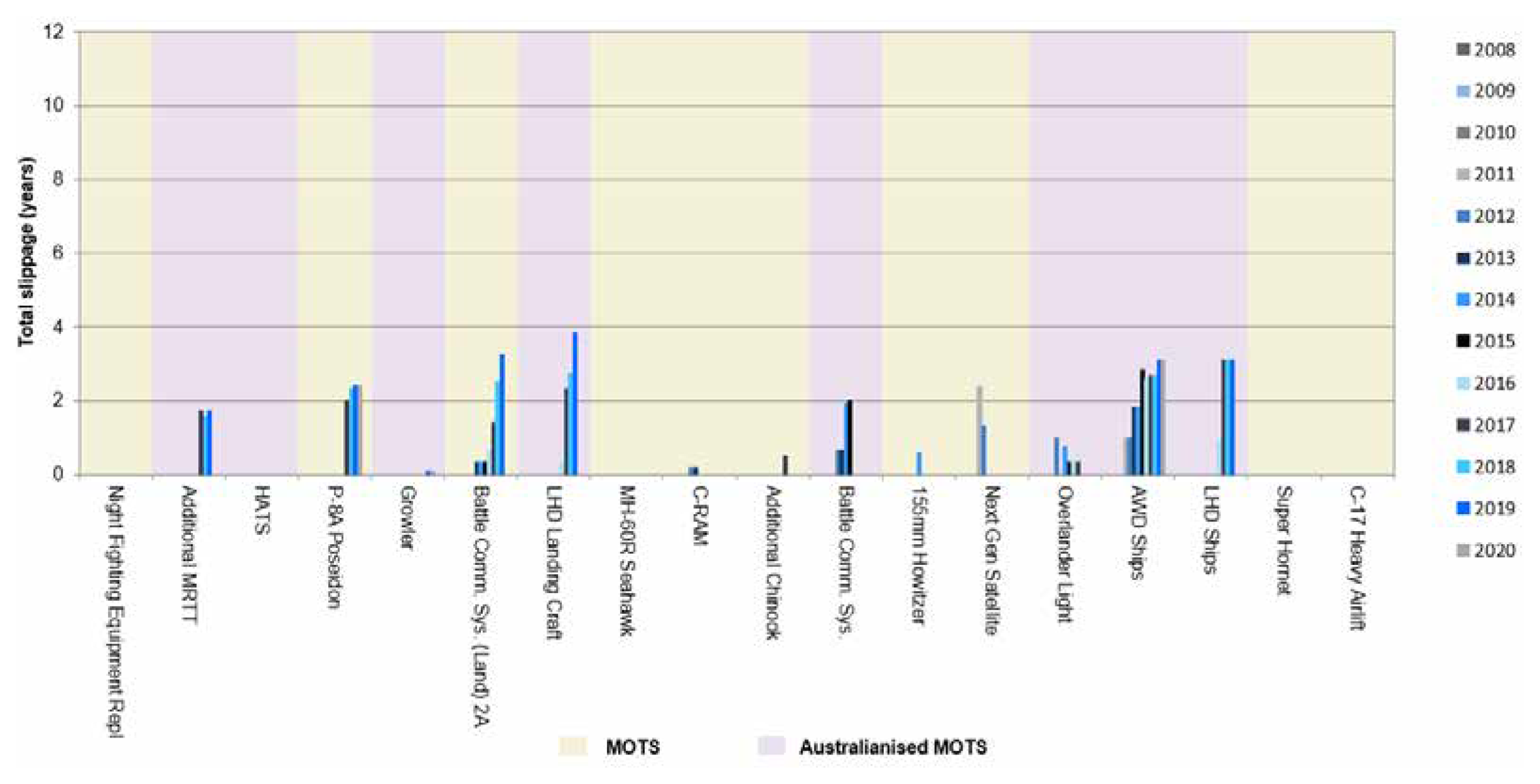

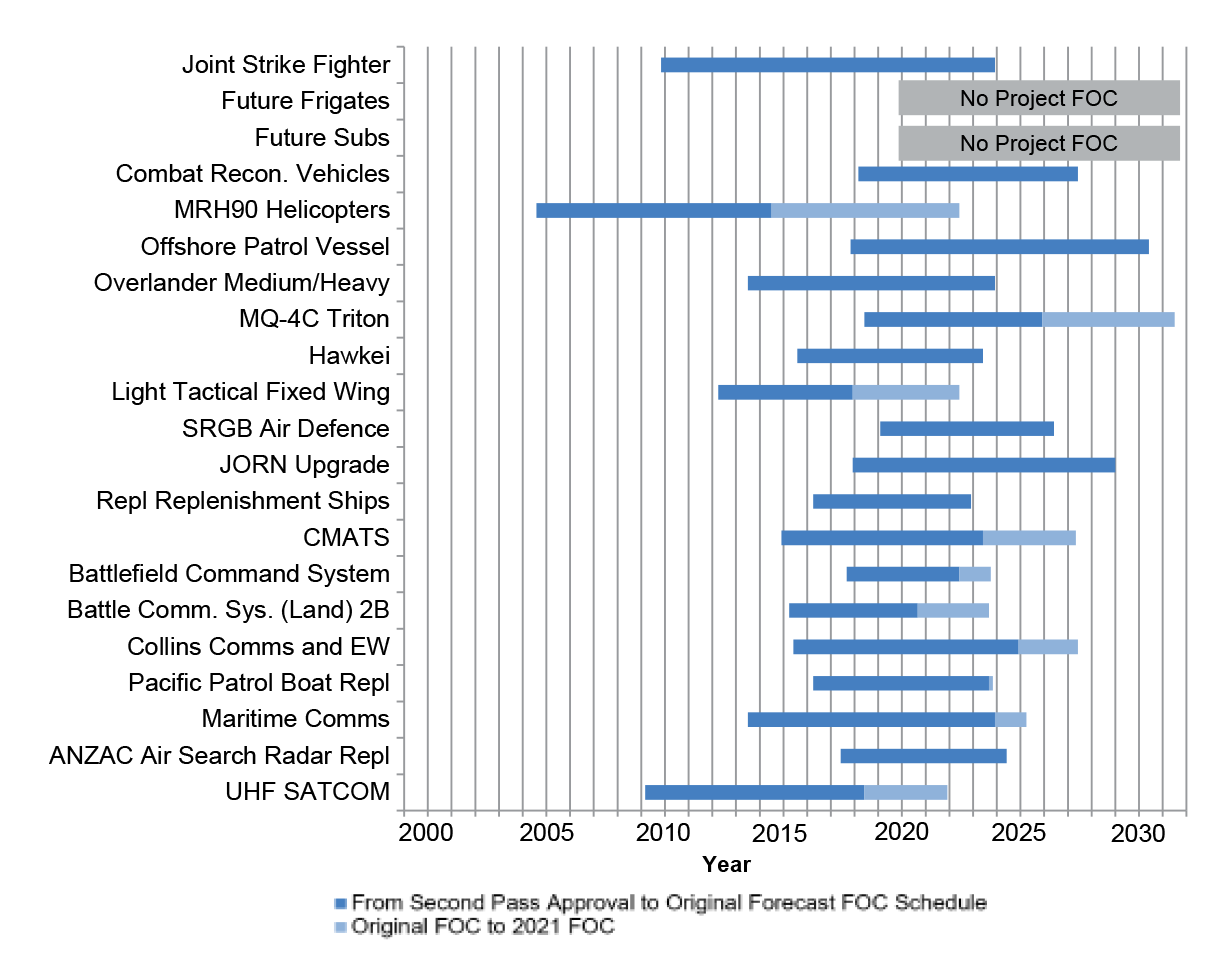

Table 3: Schedule slippage from original planned Final Operational Capability1

Project

In-year (months)

Total (months)

Project

In-year (months)

Total (months)

Joint Strike Fighter2

0

0

MQ-4C Triton2

24

67

Future Frigates2,3

N/A

N/A

Repl Replenishment Ships

0

0

Future Subs3

N/A

N/A

CMATS2,5

13

47

Combat Recon. Vehicles

0

0

Battlefield Command System2

0

16

MRH90 Helicopters2

6

95

Battle Comm. Sys. (Land) 2B

12

36

Offshore Patrol Vessel

0

0

Collins Comms and EW

0

30

Overlander Medium/Heavy

0

0

Pacific Patrol Boat Repl

0

2

Hawkei2

0

0

Maritime Comms

0

16

Light Tactical Fixed Wing2,4

18

54

ANZAC Air Search Radar Repl

0

0

SRGB Air Defence

0

0

UHF SATCOM2

0

42

JORN Upgrade2,5

N/A

N/A

Total

Total (months)

73

405

Total (per cent)

 5

 23

Note 1: Slippage refers to a delay in the current forecast date compared to the original government approved date of FOC. These figures exclude delays to a project’s schedule that do not result in slippage past the original government approved date, and schedule reductions over the life of the project.

Note 2: These projects have been identified by Defence as Projects of Interest (see paragraph 1.33).

Note 3: These projects’ FOC milestones had not been approved by government at 30 June 2021.

Note 4: Light Tactical Fixed Wing was previously called Battlefield Airlifter.

Note 5: These projects’ FOC forecasts are reported in their PDSSs as ‘TBA’. The delays are anticipated to be several years.

Source: ANAO analysis of the 2020–21 PDSSs.

30. Platform availability has contributed to the slippage experienced within some projects. For example, Maritime Comms and Collins Comms and EW have been impacted by changes to docking schedules of the ANZAC Class frigates and Collins Class submarines respectively.

31. Significant delays have also been experienced by projects with the most developmental content: MRH90 Helicopters, MQ-4C Triton, CMATS, and Battle Comm. Sys. (Land) 2B.

32. Table 4, on p.14, provides details of schedule slippage for projects which have exited the MPR. Compared to the 405 months total schedule slippage for the current 19 Major Projects with approved FOC milestones26, the 33 projects which have exited the MPR27 have reported accumulated schedule slippage of 1321 months, as at their respective exit dates.

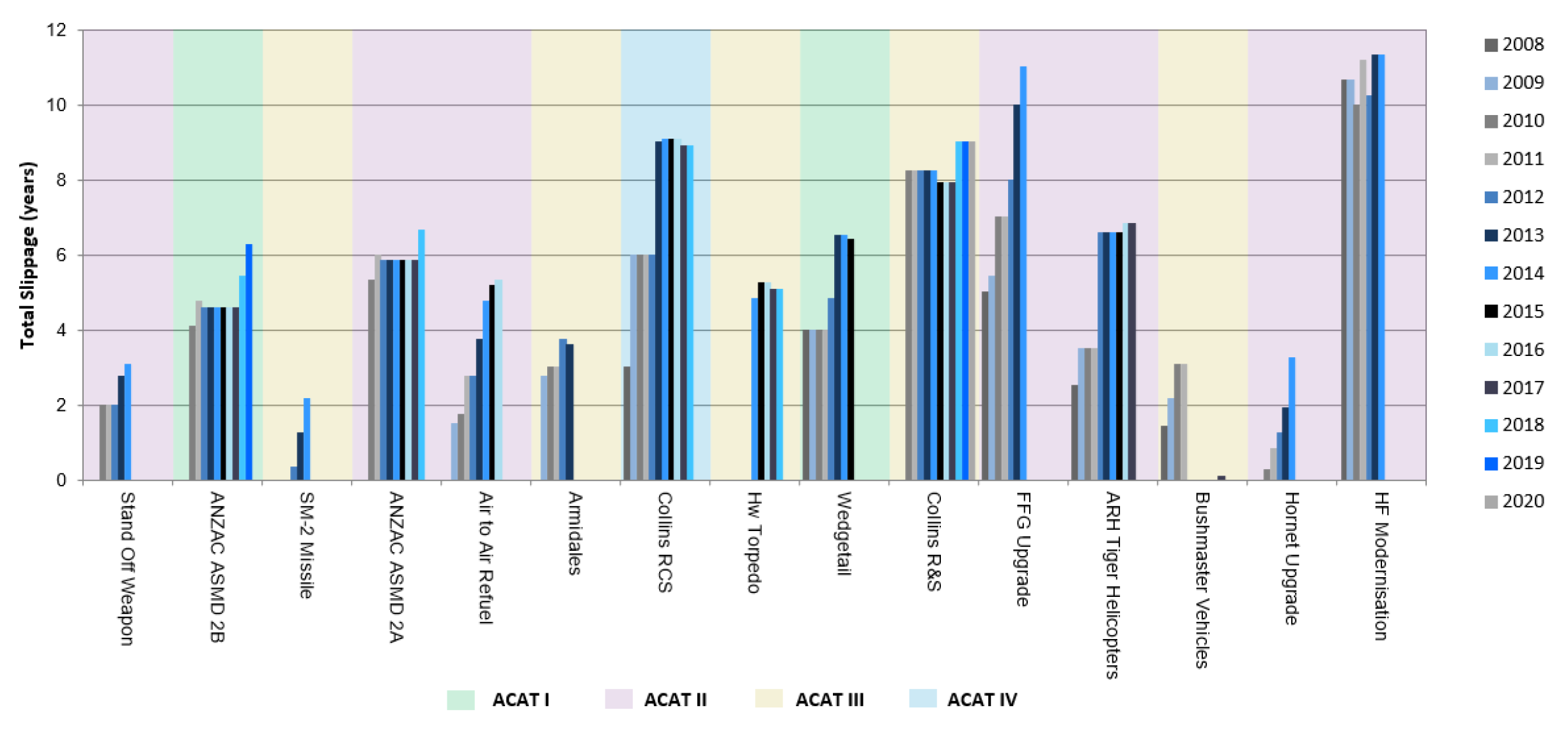

33. Table 4 indicates that schedule slippage for projects which have exited the MPR was more pronounced in projects with the most developmental content.

Table 4: Schedule slippage for projects which have exited the MPR1

Project

Total (months)

Project

Total (months)

AWD Ships (Australianised MOTS)

37

Additional Chinook (MOTS)

6

P-8A Poseidon (MOTS)

29

HF Modernisation (Developmental)

136

Wedgetail (Developmental)

77

Armidales (Australianised MOTS)

43

Super Hornet (MOTS)

0

HATS (Australianised MOTS)

0

Growler (Australianised MOTS)

1

Collins RCS (Australianised MOTS)

107

MH-60R Seahawk (MOTS)

0

Night Fighting Equip Repl (MOTS)

0

LHD Ships (Australianised MOTS)

37

Collins R&S (Australianised MOTS)

108

Hornet Upgrade (Australianised MOTS)

39

Battle Comm. Sys. (Land) 2A (MOTS)

39

ARH Tiger Helicopter (Australianised MOTS)

82

Hw Torpedo (MOTS)

61

C-17 Heavy Airlift (MOTS)

0

SM-2 Missile (Australianised MOTS)

26

Air to Air Refuel (Developmental)

64

ANZAC ASMD 2A (Australianised MOTS)

80

FFG Upgrade (Developmental)

132

155mm Howitzer (MOTS)

7

Bushmaster Vehicles (Australianised MOTS)

1

Stand Off Weapon (Australianised MOTS)

37

Overlander Light (Australianised MOTS)

4

Battle Comm. Sys. (Australianised MOTS)

24

Additional MRTT (Australianised MOTS)

21

C-RAM (MOTS)

2

Next Gen Satellite (MOTS)2

0

LHD Landing Craft (Australianised MOTS)

46

ANZAC ASMD 2B (Developmental)

75

Total

 1321

Note 1: The Hornet Refurb and Battle Management System (BMS) projects are not included in this table as they did not have FOC milestones approved by government.

Note 2: Next Gen Satellite shows slippage in Figure 7a, on p.59, which related to the final capability milestones at the time. By the time it reached FOC, a new final capability milestone had been introduced and slippage was reduced.

Source: PDSSs in Major Projects Reports and ANAO analysis.

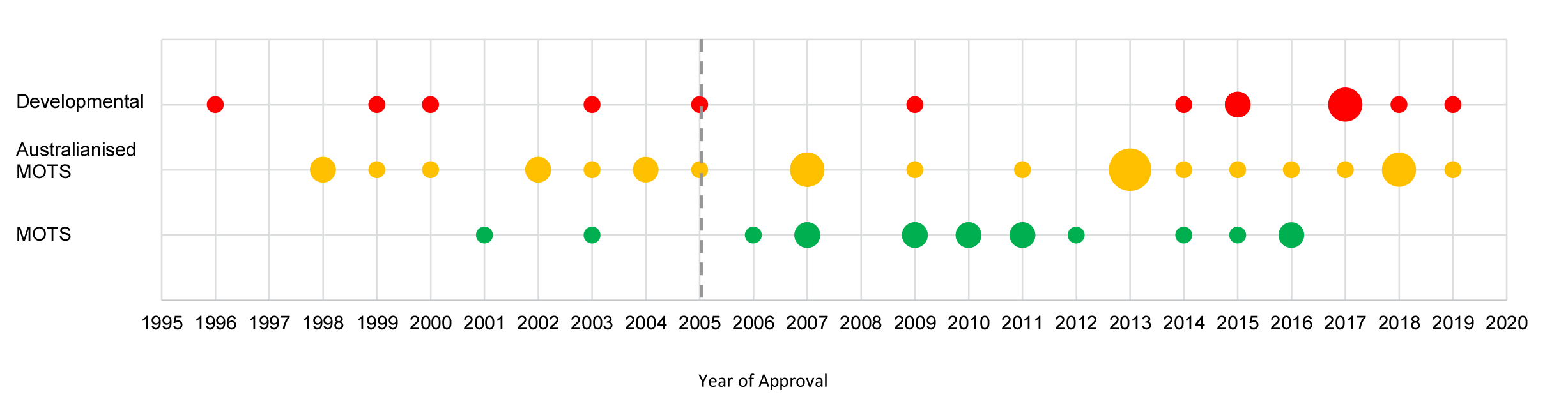

34. Additional ANAO analysis (refer to Figure 6, p.58) has compared project slippage against the Acquisition Type of projects — that is, Defence’s classification of projects as Military Off-The-Shelf (MOTS)28, Australianised MOTS or developmental. These classifications are a general indicator of the difficulty associated with the procurement process.

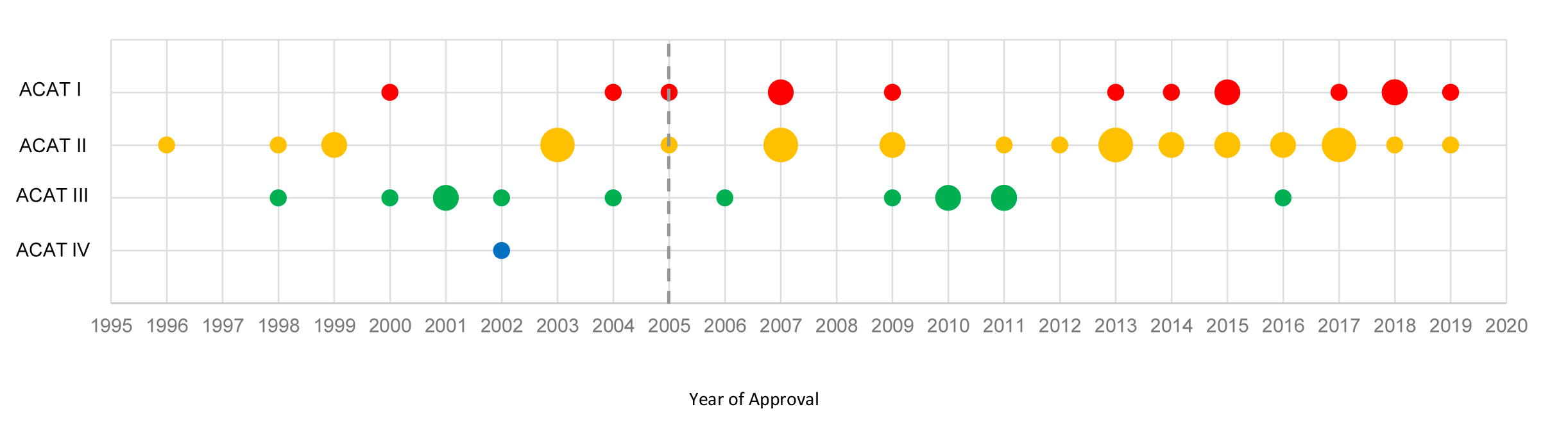

35. Figures 7a and 7b (pp.59–60) provide analysis of projects either completed, or removed from the MPR review, and shows that a focus on MOTS acquisitions has assisted in reducing schedule slippage. Prima facie, the more developmental in nature a project is, the more likely it will result in a greater degree of project slippage. The data in Figures 7a and 7b was requested by the JCPAA in May 2014.29

36. In this MPR, additional ANAO analysis has been included in relation to the Acquisition Categorisation (ACAT) level30, due to the removal of reporting against the Acquisition Type of projects in the PDSSs (see Figures 8, 9a and 9b on pp.61–63).

37. Additional reporting against the ACAT level has identified that there has been an increase of projects at the ACAT I31 and ACAT II32 levels, and that ACAT I projects currently in the MPR are reporting significantly more slippage to FOC than ACAT II projects (Figure 8, on p.61). ACAT I projects carry a higher level of technical risk.

38. Longitudinal analysis indicates that while the reasons for schedule slippage vary, it primarily reflects the underestimation of both the scope and complexity of work, particularly for Australianised MOTS and developmental projects (see paragraphs 2.34 to 2.35).

Capability

39. The third principal component of project performance examined in this report is progress towards the delivery of capability approved by government. While the assessment of expected capability delivery by Defence is outside the scope of the Auditor-General’s formal review conclusion, it is included in the ANAO analysis to provide an overall perspective of the three principal components of project performance.

40. The Defence PDSSs report that 17 projects in this year’s report will deliver all of their key capability requirements. Two projects, Light Tactical Fixed Wing33 and Battlefield Command System, report that they are unable to deliver all of the required capability by FOC. Two PDSSs (Future Frigates and Future Subs) do not include this reporting, as the projects did not have approved materiel capability to be delivered at 30 June 2021.

41. Defence’s assessment indicates that some elements of capability to be delivered by projects may be ‘under threat’, but the risk is assessed as ‘manageable’. The four project offices experiencing challenges with expected capability delivery (2019–20: five) are Joint Strike Fighter, MRH90 Helicopters, Overlander Medium/Heavy, and Battle Comm. Sys. (Land) 2B.

42. Table 5, on p.16, summarises expected capability delivery as at 30 June 2021, as reported by Defence.

Table 5: Capability delivery

Expected Capability
(Defence Reporting)

2018–19 MPR (%)

2019–20 MPR (%)

2020–21 MPR (%)

High Confidence (Green)

98

98

97

Under Threat, considered manageable (Amber)

2

2

2

Unlikely (Red)

1

1

1

Total

100

100

100

Note 1: Defence advised in these years that AWD Ships would not deliver one element of capability at FOC (which equated to approximately one per cent). However, across all the Major Projects this percentage rounded to zero per cent.

Source: PDSSs in Major Projects Reports and ANAO analysis.

43. In addition to reporting on expected capability delivery, Defence has continued the practice of including in the PDSSs declassified information on contractual remedies for projects, including stop payments and liquidated damages. During 2020–21 Battlefield Command System negotiated contractual remedies involving stop payments, and Hawkei received $6.2 million in liquidated damages via a Contract Change Proposal.

Summary longitudinal analysis

44. Table 6, on p.17, provides summary data on Defence’s progress toward delivering the capabilities for the Major Projects covered in this report, and compares current data against that reported in previous editions of the MPR.

Table 6: Summary longitudinal analysis1

2018–19 MPR

2019–20 MPR

2020–21 MPR

Number of Projects

26

25

21

Total Approved Budget at 30 June

$64.1 bn

$78.7 bn

$58.0 bn

Total Approved Budget at final Second Pass Approval

$53.9 bn

$68.9 bn

$54.2 bn

Total Expenditure Against Total Approved Budget

$36.3 bn (56.6%)

$38.9 bn (49.4%)

$28.1 bn (48.4%)

Total In-year Expenditure Against In-year Budget

$4.8 bn (93.4%)

$5.7 bn (92.5%)

$6.1 bn (98.4%)

Total Budget Variation since initial Second Pass Approval2

$24.4 bn (38.0%)

$24.2 bn (30.7%)

$18.3 bn (31.5%)

Total Budget Variation since final Second Pass Approval3

$10.2 bn (15.9%)

$9.8 bn (12.5%)

$3.8 bn (6.7%)

In-year Approved Budget Variation

$1.2 bn (1.9%)

$0.1 bn (0.1%)

-$1.0 bn (-1.7%)

Total Schedule Slippage4

651 months (25%)

507 months (21%)

405 months (22%)

Average Schedule Slippage across Projects4a

25 months

22 months

23 months

In-year Schedule Slippage

92 months (4%)

68 months (3%)

73 months (4%)

Total Reported Risks and Issues5, 6

138

142

119

Expected Capability (Defence Reporting)7

  • High level of confidence of delivery (Green)

98%

98%

97%

  • Under threat, considered manageable (Amber)

2%

2%

2%

  • Unlikely to be met (Red)

0% 8

0% 8

1%

Refer to paragraphs 19 to 42 in Part 1 of this report.

Note 1: The data for the 21 Major Projects in the 2020–21 MPR compares the data from projects in the 2019–20 MPR and 2018–19 MPR. The Major Projects included within each MPR are based on entry and exit criteria in the Guidelines, which have been included in Part 4 of this report. The entry and exit of projects should be considered when comparing data across years.

Note 2: Where a project has multiple Second Pass Approvals, the MPR has historically reported budget variations from the initial Second Pass Approval. The figures in this row are consistent with prior year reporting. See Table 2 for a breakdown of the major components of this variance, and Table 8 on pp.42–45 for all real variations.

Note 3: Where a project has multiple Second Pass Approvals, the budget at Second Pass Approval reported in the Header refers to the total budget as at the final Second Pass Approval. The figures in this row use this methodology.

Note 4: Slippage refers to a delay in the current forecast date compared to the original government approved date of FOC. Slippage can occur due to late delivery, increases in scope or at times can be a deliberate management decision.

Note 4a: As shown in Table 3 on p.13 and Table 11 on p.68 of this report, for the ten 2020–21 major projects which have experienced slippage, the range is 2 to 95 months of total slippage.

Note 5: The grey section of the table is excluded from the scope of the ANAO’s priority assurance review, due to a lack of systems from which to obtain complete and accurate evidence in a sufficiently timely manner to facilitate the review.

Note 6: The figures represent the combined number of open ‘high’ and ‘extreme’ risks and issues reported in the PDSSs across all projects. Risks and issues may be aggregated at a strategic level.

Note 7: These figures represent the average predicted capability delivery across all of the Major Projects. This method reduces the effect of any individual project’s size on the aggregate figure. Previously, these figures were calculated based on the number of distinct capability measures defined by each project and therefore projects with more capability measures had more of an effect on the aggregate figure.

Note 8: Defence advised in these years that AWD Ships would not deliver one element of capability at FOC (which equated to approximately one per cent). However, across all the Major Projects this percentage rounded to zero per cent.

Impact of COVID-19 on the selected Major Projects

45. Sixteen of the 21 Major Projects reported in their PDSS that they experienced an impact as a result of the COVID-19 pandemic.34 Of these 16 projects, six reported impacts across multiple areas.

Cost / budget

46. Six projects reported an impact on project budget as a result of the COVID-19 pandemic. These six projects experienced an underspend, citing varying reasons for this (delay to training and support, overseas suppliers, shipyard closures and international travel restrictions). One of these projects has highlighted an impact to the budget as an emerging issue.

Schedule

47. The 16 projects that reported an impact on scheduling as a result of the COVID-19 pandemic included factors relating to:

  • supplier disruption (supplier production and/or shipping delays);
  • workforce limitations relating to travel (specialists and crew were due to travel both interstate and from other countries to work with/on the projects or to deliver/undertake training) and social distancing restrictions; and/or
  • contractor delays (scope, delivery and certification delays).

Capability

48. No projects reported an impact to capability delivery as a result of the COVID-19 pandemic.

1. The Major Projects Review

1.1 This chapter provides the Australian National Audit Office’s (ANAO) overview of the scope and approach adopted for its limited assurance review of the 21 Project Data Summary Sheets (PDSSs) prepared by the Department of Defence (Defence) for this year’s Major Projects Report (MPR). The chapter also includes information and commentary on developments in Defence’s acquisition governance processes, based on the ANAO’s review.

Review scope and approach

1.2 In 2012 the Parliament’s Joint Committee of Public Accounts and Audit (JCPAA) identified the ANAO’s review of Defence PDSSs as a priority assurance review, under subsection 19A(5) of the Auditor-General Act 1997 (the Act). This provided the ANAO with full access to the information gathering powers under the Act. The ANAO’s review of the individual PDSSs, which are included in Part 3 of the MPR, was conducted in accordance with the auditing standards set by the Auditor-General under section 24 of the Act through the incorporation of the Australian Standard on Assurance Engagements (ASAE) 3000 Assurance Engagements Other than Audits or Reviews of Historical Financial Information, issued by the Australian Auditing and Assurance Standards Board.

1.3 The following forecast information provided by Defence is excluded from the scope of the ANAO’s review: capability delivery; risks and issues; and forecast dates. These exclusions are due to the lack of Defence systems from which to provide complete and accurate evidence35, in a sufficiently timely manner to complete the review. Accordingly, the Independent Assurance Report by the Auditor-General does not provide any assurance in relation to this information. However, material inconsistencies identified in relation to this information are required to be considered in forming the Auditor-General’s conclusion.

1.4 The ANAO’s work is appropriate for the purpose of providing an Independent Assurance Report in accordance with the ANAO Auditing Standards. However, the review of individual PDSSs is based on a limited assurance approach and is not as extensive as individual performance audits and financial statement audits conducted by the ANAO, in terms of the nature and scope of issues covered, and the extent to which evidence is required by the ANAO. Consequently, the level of assurance provided by this review, in relation to the 21 major Defence equipment acquisition projects (Major Projects), is less than that provided by the ANAO’s program of performance and financial statement audits.

1.5 Separately, the ANAO reviews developments in Defence’s acquisition governance processes (information and commentary on governance issues appears in this chapter) and undertakes analysis of key elements of the PDSSs (information and commentary on systemic issues and longitudinal analysis for the 21 projects reviewed appears in the next chapter).

1.6 The ANAO’s review was conducted in accordance with the ANAO Auditing Standards at a cost to the ANAO of approximately $1.8 million.

Review methodology

1.7 The ANAO’s review of the information presented in the individual Defence PDSSs included:

  • examination and assessment of the governance and oversight in place to ensure appropriate project management;
  • an assessment of the systems and controls that support project financial management, risk management and project status reporting within Defence;
  • an examination of each PDSS and the documents and information relevant to them;
  • a review of relevant processes and procedures used by Defence in the preparation of the PDSSs;
  • discussions with persons responsible for the preparation of the PDSSs and management of the projects;
  • analysis of project information, for example, cost and schedule variances;
  • taking account of industry contractor comments provided on draft PDSS information;
  • assessing the assurance by Defence managers attesting to the accuracy and completeness of the PDSSs;
  • examination of the representations by the Chief Finance Officer supporting the project financial assurance and contingency statements;
  • examination of confirmations, provided by the Capability Managers, relating to each project’s progress toward Initial Materiel Release (IMR), Final Materiel Release (FMR), Initial Operational Capability (IOC) and Final Operational Capability (FOC); and
  • examination of the Statement by the Secretary of Defence, including significant events occurring post 30 June, and management representations by the Secretary of Defence.

1.8 The ANAO’s review of PDSSs also focused on project management and reporting arrangements contributing to the overall governance of the Major Projects. The ANAO considered:

  • developments in acquisition governance (see paragraphs 1.10 to 1.48, below);
  • the financial framework, particularly as it applies to the project financial assurance and contingency statements (see Section 2 of the PDSSs);
  • schedule management and test and evaluation processes (see Section 3 of the PDSSs);
  • materiel capability / scope delivery forecast assessments, including Defence statements of the likelihood of delivering key capabilities, particularly where caveats are placed on the Capability Manager’s declaration of significant milestones (see Section 4 of the PDSSs);
  • changes due to Defence’s reform of the Defence Enterprise Risk Management Framework, and the completeness and accuracy of major risk and issue data (see Section 5 of the PDSSs); and
  • the impact of acquisition issues on sustainment to ensure the PDSS is a complete and accurate representation of the acquisition project.

1.9 This review activity informed the ANAO’s understanding of the systems and processes supporting the PDSSs for the 2020–21 review period. It also highlighted issues in those systems and processes that warrant attention.

Acquisition governance

1.10 Consistent with previous years, the ANAO considered Defence’s Major Project acquisition governance processes when planning and conducting the review for the 2020–21 MPR. While some of these processes are now established, others continue to mature or require further development to achieve their intended impact.

Defence Independent Assurance Reviews

1.11 The Defence Independent Assurance Review (IAR) process provides the Defence Senior Executive with assurance that projects and products will deliver approved objectives and are prepared to progress to the next stage of activity. These management-initiated reviews consider a project’s status while sufficient time remains for corrective action to be implemented.36,37

1.12 IARs are intended to commence at project initiation and are conducted through to FOC; for higher-complexity projects, ideally on an annual basis. They are an important input to key acquisition and sustainment decision points or milestones.38

1.13 Fifteen of the 21 Major Projects had an IAR conducted during 2020–2139, which formed key evidence for the ANAO’s review.

1.14 The ANAO recently published two performance audit reports which recommended improvements in Defence IAR processes.

1.15 Auditor-General Report No.12 2020–21 Defence’s Procurement of Offshore Patrol Vessels — SEA 1180 Phase 1 made two recommendations: that Defence plan the sequencing of IAR activity undertaken during a platform selection process in order to avoid conflicts with other processes and to ensure access to all relevant information; and that Defence maintain Commonwealth records, document and retain all evidence and advice regarding its decision-making in procurement.

1.16 Auditor-General Report No.18 2020–21 Defence’s Procurement of Combat Reconnaissance Vehicles (LAND 400 Phase 2) included a recommendation that Defence should review the process in place to provide assurance to its senior leadership that agreed IAR recommendations have been implemented appropriately and in a timely manner.

1.17 The assessment of whether these recommendations have been implemented by Defence is outside the scope of this review. The Defence Audit and Risk Committee has accepted closure of the two recommendations from Auditor-General Report No.12 of 2020–21 Defence’s Procurement of Offshore Patrol Vessels — SEA 1180 Phase 1. Reporting is yet to be provided to the Committee on the status of the recommendation in Auditor-General Report No.18 of 2020–21 Defence’s Procurement of Combat Reconnaissance Vehicles (LAND 400 Phase 2).

Projects of Concern

1.18 The Projects of Concern process is intended to focus the attention of the highest levels of government, Defence and industry on remediating problem projects.40 As at 30 June 2021, one MPR project, MRH90 Helicopters, was a continuing Project of Concern. The project was placed on the list in November 2011 due to contractor performance relating to significant technical issues preventing the achievement of milestones on schedule.41 The project has progressed the materiel capability delivery relating to the Taipan Gun Mount, Aero-Medical Evacuation Equipment and the Common Mission Management System.42 FOC is scheduled for June 2022, six months later than stated last year. In October 2021, it was reported that Navy may replace its six MRH90 Helicopters with 12 additional Seahawk helicopters.43 Defence advised the ANAO in November 2021 that while the United States Government had approved the sale of MH-60R helicopters to Australia, the Australian Government had not yet approved the purchase.

1.19 Auditor-General Report No.31 2018–19 Defence’s Management of its Projects of Concern assessed whether Defence’s Projects of Concern regime was effective in managing the recovery of underperforming projects. It concluded that, while the regime is an appropriate mechanism for escalating troubled projects to the attention of senior managers and ministers, Defence was not able to demonstrate the effectiveness of its regime in managing the recovery of underperforming projects. Moreover, the audit observed that the transparency and rigour of the framework’s application has declined in recent years. The ANAO recommended that:

  • Recommendation No.1: Defence introduce, as part of its formal policy and procedures, a consistent approach to managing entry to, and exit from, its Projects of Interest and Projects of Concern lists. This should reflect Defence’s risk appetite and be made consistent with the new Capability Acquisition and Sustainment Group Risk Model and other, Defence-wide, frameworks for managing risk. To aid transparency, the policy and the list should be made public.
  • Recommendation No.2: Defence evaluates its Projects of Concern regime.44

1.20 In July 2020 Defence closed both these recommendations, advising that the Capability Acquisition and Sustainment Group (CASG) had developed a consistent approach to entry and exit from the Projects of Interest and Projects of Concern lists; that the Projects of Concern list was publicly available; and that CASG had evaluated the Projects of Concern regime and had effective assurance mechanisms in place, underpinned by IARs.45

1.21 Auditor-General Report No.34 2020–21 Implementation of ANAO and Parliamentary Committee Recommendations — Department of Defence concluded that the two recommendations relating to the management of Projects of Concern had not been implemented. The ANAO reported that there was no evidence that Defence established a clear basis or criteria to ensure a consistent approach to entry to and exit from the Projects of Concern or Projects of Interest lists, and that no evidence of an evaluation was provided to the ANAO.46

1.22 At the JCPAA’s September 2021 hearings on the 2019–20 Major Projects Report, the Deputy Secretary CASG stated that:

We are working to improve the way in which we’re able to measure the underperforming projects. Invariably, it’s data driven quite easily on cost and schedule against the documented milestones and loaded milestones and then the capability a little more to that. As we develop up the program report or the project and sustainment report that we’re doing to supplement the sequencing in between portfolio budget statements, portfolio additional estimates statements and from this major projects report itself, we will continue to mature that by feeding in capability manager assessments and information. That’s important because, ultimately, they are the first principles responsible for the capability delivery and we are the delivery agency but the operational effect is through the capability manager.47

1.23 The ANAO noted during the preparation of the 2020–21 MPR that the Future Subs project was not listed as a Project of Concern or a Project of Interest.

1.24 The Future Subs project was included for the first time in the 2019–20 MPR. Since its entry to the MPR, the Future Subs PDSS has included a risk in Section 5.1 that: ‘There is a risk that our Program Partners will not adequately address issues and challenges (including technical risks) that arise during the course of the Program’.48 Defence reported that this risk was being remediated as follows: ‘Contracted requirements exist on Program performance, behaviours and expectations and are supported by: ongoing engagement with CEO’s; bilateral and tripartite governance arrangements; and ongoing independent critical peer review by the Naval Shipbuilding Advisory Board and Submarine Advisory Committee.’ The ANAO was advised by Defence in 2020‍–‍21 that the Future Subs project was not considered as a candidate for inclusion as a Project of Concern or Interest because it was already subject to the most senior levels of governance and scrutiny. Defence further advised that this included more frequent reporting to ministers and government, which Defence advised was effectively consistent with the reporting expectations of a Project of Concern or Interest even if the project was not formally included in that framework.

1.25 On 16 September 2021 the Australian Government announced a change in strategic direction for the Future Subs project, stating that: ‘The pursuit of nuclear-powered submarine technology means that Australia will no longer proceed with the Attack class conventional submarine program with Naval Group’.49

Quarterly Performance Report and Project and Sustainment Report

1.26 The aim of the Capability Acquisition and Sustainment Quarterly Performance Report (QPR) was to provide senior stakeholders within government and Defence with insight into the delivery of capability to the Australian Defence Force.50 The report was provided to the Minister for Defence and the Minister for Defence Industry on a quarterly basis.51

1.27 In July 2019, the ANAO completed an audit on the effectiveness of the QPR in providing senior stakeholders with accurate and timely information on the status of projects and emerging risks and issues. It found the June 2018 QPR, reviewed by the ANAO, to be largely effective, contained mostly accurate information, and was valued by senior stakeholders.52 The ANAO recommended that Defence improve the QPR as a tool for senior leaders by reporting on:

  1. trend performance data for sustainment products; and
  2. emerging candidates for the Projects/Products of Concern list and Products/Projects of Interest list that have been recommended by an Independent Assurance Review or which are under active consideration by senior management.53

1.28 During its review for the 2018–19 MPR, the ANAO observed that Defence’s June 2019 QPR reported on both improved and deteriorated performance for both acquisition and sustainment products since the previous QPR. This reflected a change in trend reporting consistent with the agreed ANAO recommendation. Additionally, the ANAO observed that Defence’s June 2019 QPR reported the emerging candidates for the Projects/Products of Concern list and Products/Projects of Interest list which had been recommended either by an IAR or which were under active consideration. This change was also consistent with the agreed ANAO recommendation.54 Defence closed this recommendation in March 2020.55

1.29 CASG ceased producing QPRs after June 2020, with the report superseded in February 2021 by the Project and Sustainment Report (PSR). For the 2020–21 MPR review, the ANAO examined the February 2021 PSR as part of the procedures for its limited assurance review of Defence’s PDSSs.56 The February 2021 PSR covered the reporting period since the last QPR in June 2020, and contained detailed reporting on Projects/Products of Concern and Projects/Products of Interest, information on reform and governance activities, significant events, Domain overviews and performance analysis and trends comparing data to previous reporting periods, and indicative overviews of Defence’s Top 30 acquisition and sustainment projects.

1.30 During Budget Estimates hearings held on 1 June 2021, the Deputy Secretary CASG stated that the PSR was anticipated to be issued on a six-monthly basis.57

1.31 A six-month gap in reporting activity introduces a risk of diminished information being available for decision making by senior leaders. Further, compared to the QPR, the PSR contains less information on acquisition projects and sustainment products that are not classified as a Project/Product of Concern or Project/Product of Interest.

1.32 Defence advised the ANAO in September 2021 that it has ‘management processes that ensure Capability Managers and Delivery groups are informing the Secretary of Defence and the Chief of Defence Force through weekly roundtable discussions and the Ministers are … informed on pertinent issues as they arise’. Defence also advised the ANAO that the next PSR was still in development and a draft would not be ready prior to the completion of the 2020‍–‍21 MPR.

1.33 In October 2021, Defence further advised the ANAO that the PSR was only an interim report, and that a new ‘Capability Report’ originally intended to replace the QPR was not sufficiently mature to be implemented. The new report was yet to be named, and would not be ready before the end of 2021.

1.34 Defence’s February 2021 PSR identified nine MPR projects as Projects of Interest58:

  • Joint Strike Fighter — the PSR notes that contingency plans have been enacted to counteract the impacts of COVID-19 to build capability and support systems.59
  • Future Frigates — included due to size, complexity, risk profile and media interest. The PSR notes that all scheduled activities have been progressing as planned, although some will need to be reassessed in light of COVID-19 restrictions.60
  • MQ-4C Triton — the PSR notes that the United States Navy announced a production funding suspension for its Triton program until 2023. The suspension will have capability, schedule and cost implications, and potential sustainment cost and capability impacts. The project is undergoing a fundamental review.61
  • Hawkei — the PSR notes concerns around reliability, design and production delays, and that a brake related incident has further delayed the forecast IOC.62
  • Light Tactical Fixed Wing63 — FOC was not met in December 2019 and the PSR notes that ‘residual’ activities remain outstanding, including fleet fitment and certification of Mode 5 Identification Friend or Foe and remediation of the Missile Approach Warning System. Air Force revised scope for the residual activities required to achieve FOC has been provided to government for consideration.64
  • JORN Upgrade — the PSR notes that engineering milestone delays may impact FOC.65
  • CMATS — the PSR notes some reduction of tower capability and the ongoing need for Airservices Australia to implement cost saving changes agreed with Defence.66
  • Battlefield Command System — the PSR notes schedule risks due to vehicle integration issues.67
  • UHF SATCOM — the PSR notes that the Network Control System experienced software development delays and security and integration issues.68,69

1.35 These reported issues with the Projects of Interest align with the results of the ANAO’s review of the relevant PDSSs. Delays to progress have impacted the delivery schedule of MQ-4C Triton, Light Tactical Fixed Wing, and CMATS during 2020–21.70

Project Directives and Materiel Acquisition Agreements

1.36 Project Directives (previously known as Joint Project Directives) state the terms of government approval, reflecting the approved scope and timeframes for activities, responsibilities and resources allocated, and key risks and issues.71 Project Directives have historically been used to inform internal Defence documentation such as Materiel Acquisition Agreements (MAAs) between CASG and the Service Chiefs.72,73 Project Directives had previously been described as a key governance document under the Capability Life Cycle74, intended to ensure that all parties in Defence are informed of government decisions.

1.37 Defence updated the Capability Life Cycle Manual in June 2020, no longer referring to Project Directives as a key governance document. The Capability Life Cycle Manual was superseded by the Defence Capability Manual in December 2020. The Defence Capability Manual also does not refer to Project Directives. Defence has advised the ANAO that government decisions are recorded in CapabilityOne, which records government decisions in relation to a project. In some cases, the Joint Force Authority may provide a specific documented directive. The ANAO has previously highlighted the importance of ensuring that Project Directives properly reflect the relevant government decision, and that MAAs are appropriately aligned with the relevant Project Directive.75

1.38 Of the two new projects entering the 2020–21 MPR, only the JORN Upgrade project advised the ANAO that it had direct access to government approval documentation. The SRGB Air Defence project advised that it did not have direct access to government approval documentation. Last year, the Future Subs, Combat Recon. Vehicles and Battlefield Command System projects advised that they did not have access to government approvals.

1.39 In November 2020, Defence advised the ANAO that ‘the internal Cabinet Liaison Services section provides advice to Defence in relation to information pertaining to government approvals. Where a Project has not been identified as having a need to know, the Project can request access to relevant Cabinet documents via a business case.’

1.40 The risk of misalignment or error is reduced if Defence has appropriate access to government records, such as that previously provided by Project Directives. If projects can access original Cabinet documentation, there is no residual impact.

1.41 The ANAO requires access to original approval documents to validate the requirements of projects. Validation based on internal Defence documentation is not always possible or may not meet evidentiary standards.

1.42 First advised by Defence in July 201676, Product Delivery Agreements (PDAs)77 were to be developed to replace the existing MAAs and Materiel Sustainment Agreements (MSAs). Defence advised the ANAO during preparation of the 2020–21 MPR that this initiative is still in the concept phase and will not apply until a PDA framework is approved and implemented. In October 2021, Defence advised the ANAO that in the absence of the PDA framework, Capability Managers and Delivery Groups continue to use the Materiel Acquisition Agreement and Materiel Sustainment Agreement Framework.

Smart Buyer Framework

1.43 The 2015 First Principles Review recommended the construction of a ‘smart buyer’ framework, with the aim of ‘[ensuring] Defence can make strategic decisions regarding the most appropriate procurement and contracting methodologies’. Defence has begun to conduct Smart Buyer assessments for acquisition projects at different stages of approval. None of the projects currently in the Major Projects portfolio have been approved under the Smart Buyer processes.

1.44 Defence advised the ANAO that no MPR projects have been considered by the Smart Buyer Framework in 2020–21. Of the two projects entering the MPR in 2020–21, neither was approved under the Smart Buyer process, although SRGB Air Defence participated in a pilot workshop while the Smart Buyer framework was still being defined, and JORN Upgrade conducted an informal, internal assessment against the Smart Buyer criteria. The ANAO also observed that Smart Buyer workshops were being held for future tranches and phases of projects in the MPR.

Business systems

1.45 Defence continues to review its business systems with the aim of consolidating them to provide a more manageable ICT environment. During 2019–20, CASG continued to report on the status of acquisition projects in the Monthly Reporting System (MRS), which formed part of the evidence for the ANAO’s review of the PDSSs. In July 2020, Defence discontinued the MRS and project reporting now occurs via the Monthly Reporting Module (MRM). Defence advised the ANAO that MRM replicates the functionality of MRS while delivering an updated platform and user interface. A second new system, the Project Performance Report Information Platform (PPRIP), delivers a platform for projects to also conduct monthly reviews of their project and enable the raising of risks and actions with line management.

1.46 As the MRM was implemented in the 2020–21 financial year, the ANAO reviewed Defence’s use of the MRM for the 2020–21 MPR. As the replacement for the MRS, the MRM should provide information that can be used to support disclosures in Defence’s PDSSs.

1.47 During the preparation of the 2020–21 MPR, Defence advised the ANAO that the MRM could be used as a source of evidence for the PDSSs; however, as the MRM is not entirely system generated, ANAO concerns remain regarding its consistency and accuracy. The ANAO identified errors within MRM reports and therefore their reliability was not sufficient as supporting evidence for the MPR. Alternate evidence was sourced to verify the PDSSs. With regard to the errors in MRM identified by the ANAO, Defence advised the ANAO in November 2021 that:

In relation to the internal processes to assess accuracy and completeness, the process has been: data checking and reconciliation work with DFG to ensure BORIS file uploads reflect the accrual accounting position (complete Oct 20); daily automated system checks to ensure that data flows are maintained and messages are provided to users when data is not up to date; prior to each MRM lockdown period reminders on data requirements are sent to reduce human error; after each lockdown period system statistics are used to drive lessons on sign off and identify areas of improvement; and to assure that in each reporting round if the data was accurate trend information over time is used to identify anomalies and drive improvements.

1.48 These checks do not appear to be fully effective as the ANAO’s review identified anomalies in the MRM data, and alternate evidence had to be obtained. The ANAO will continue to monitor the completeness and accuracy of data in MRM.

Results of the ANAO’s review

1.49 The following sections outline the results of the ANAO’s review. The results inform the overall conclusion in the Independent Assurance Report by the Auditor-General for 2020–21.

Financial framework

1.50 The project financial assurance statements were introduced in the 2011–12 MPR and have been included within the scope of the Independent Assurance Report by the Auditor-General since 2014–15. The contingency statements were introduced for the first time in the 2013–14 MPR and describe the use of contingency funding to mitigate project risks. Together, they are aimed at providing greater transparency over projects’ financial status.

1.51 A project’s total approved budget comprises:

  • the allocated budget, which covers the project’s approved activities, as indicated in the MAA; and
  • the contingency budget, which is set aside for the eventuality of risks occurring and includes unforeseen work that arises within the delivery of the planned scope of work.78

1.52 In 2020–21, the ANAO reviewed the financial framework as it applied to managing project budgets and expenditure, including: project financial assurance, contingency, the reporting environment, and reporting cost variations and personnel costs.

Project financial assurance statement

1.53 The project financial assurance statement’s objective is to enhance transparency by providing readers with information on each project’s financial position (in relation to delivering project capability) and whether there is ‘sufficient remaining budget for the project to be completed’.79 The project financial assurance statement is restricted to the current financial contractual obligations of Defence for these projects, including the result of settlement actions and the receipt of any liquidated damages, and current known risks and estimated future expenditure as at 30 June 2021.

1.54 In the 2018–19 MPR, the ANAO identified an instance where project scope worth $1.5 billion was transferred to other projects or other phases of that program without a corresponding transfer of funds out of the project budget.80 The ANAO has not observed any such transfers of project scope in the 2020–21 financial year, however, the Light Tactical Fixed Wing project reduced its scope during 2020–21 without a corresponding Real Cost Decrease. The Light Tactical Fixed Wing project office was unable to quantify the value of this reduction in scope, but advised that it anticipated returning unspent funds at project closure. The Battlefield Command System project also expects to reduce its scope, following government consideration. As at 30 June 2021, discussions from the outcomes of a technical review and finance review were underway to determine the way forward for this project.

1.55 The Chief Finance Officer’s representation letter to the Secretary of Defence on the 2020‍–‍21 MPR’s project financial assurance statements was unqualified.

Contingency statements and contingency management

1.56 The purpose of the project contingency budget is to estimate the inherent cost, schedule and technical uncertainties of projects’ in-scope work.81 Defence policy requires that project managers ensure that all decisions in regard to a project’s contingency budget are included in the project’s contingency budget log to ensure ongoing transparency and traceability. Defence’s Project Risk Management Manual (PRMM version 2.5, p.105) requires that contingency be applied for identified risk mitigation activities.

1.57 Contingency provisions are approved by government as part of the total project budget, though are not programmed or funded in cash terms82 and projects are encouraged to meet contingency funding requirements from within their currently programmed cash funding. If this cannot be achieved, a project may propose to access contingency funding from the relevant capital program — the Approved Major Capital Investment Program (AMCIP), Facilities and Infrastructure Program (FIP) and ICT Capital Program. If this cannot be achieved, the contingency call will be presented to the Defence Investment Committee, which if agreed will potentially be met by budget offsets across the whole Integrated Investment Program.83

1.58 Defence PDSSs are required to include a statement regarding the application of contingency funds during the year, if applicable, as well as disclosing the risks mitigated by the application of those contingency funds.

1.59 In 2020–21, two Major Projects, MRH90 Helicopters and Battle Comm. Sys. (Land) 2B, had accessed their contingency funds. The MRH90 Helicopters project committed $34.4 million of contingency to mitigate supportability and performance risks. The Battle Comm. Sys. (Land) 2B project used $30.3 million of contingency funds to address delay for the Defence Tactical Communications Network and refinement of specifications for the Headquarters on the Move capability.

1.60 The ANAO’s examination of project contingency logs as at 30 June 2021 highlighted that the clarity of the relationship between contingency allocation and identified risks continues to be an issue. Five projects (Future Frigates, Combat Recon. Vehicles, Offshore Patrol Vessel, Repl Replenishment Ships, and Pacific Patrol Boat Repl) did not explicitly align their contingency log with their risk log to ensure that the expected cost impact of risks is maintained effectively, as required by PRMM version 2.5. One project (JORN Upgrade) did not have an up to date risk log as the project is in the process of renegotiating a new approach to deliver the project with its prime contractor. Defence advised the ANAO that the JORN Upgrade risk log will be updated once the negotiations are finalised, and the associated Contract Change Proposals have been executed.

1.61 The ANAO will continue to monitor non-compliance with PRMM version 2.5 and the release of specific guidance following the implementation of the CASG Risk Management Framework, which is expected to be implemented in stages to 2022 (as discussed from paragraph 1.72).

Reporting on cost variations, project personnel numbers and costs

1.62 In May 2018, the JCPAA wrote to the Auditor-General to request that the ANAO report back to it ‘on how Defence major project cost variations and the costs of retaining project staff over time might be reported annually in future Major Projects Reports.’84

Cost variations since Second Pass Approval

1.63 Table 8, at pp.42–45, shows all budget variations post initial Second Pass Approval for projects.

Project personnel numbers and costs

1.64 In terms of calculating the cost of retaining project staff, Defence advised the ANAO in November 2018 that its IT systems did not provide a direct mapping of personnel to projects. It noted that personnel often work on multiple projects and sustainment activities at any given time.

1.65 The ANAO observed during fieldwork in 2019 that several MPR projects had staff who worked concurrently on other projects, which included shared corporate staff. Some of these projects did not have systems in place to record accurately the proportion of time these shared staff attributed to the project. The ANAO also observed that MPR projects used different methods to record personnel data. These observations were repeated in 2020 and 2021.

1.66 In April 2020, the Defence Finance Group (DFG) indicated that it was possible to extract employee expenses (excluding contractors) from Defence’s personnel system, known as the Personnel Management Key Solution (PMKeyS). DFG advised the ANAO that it would need to work with Defence People Group to ensure that all relevant Department IDs within PMKeyS for a project have been captured, as well as ensuring that people are properly allocated to the correct Department IDs. In November 2020 Defence advised the ANAO that it continued to investigate whether PMKeyS could be used as a robust source to track employee costs by project.

1.67 In September 2021 Defence advised the ANAO that it is still not yet able to provide the staff cost component of projects and that its systems are not capable of calculating the cost of retaining project staff over time. Accordingly, Defence has not provided any data on the costs of project staff for projects in the MPR. The ANAO will continue to monitor Defence’s progress in recording project personnel numbers.

Enterprise Risk Management Framework

1.68 While major risks and issues data in the PDSSs remains excluded from the formal scope of the Auditor-General’s Independent Assurance Report85, material inconsistencies identified in relation to this information are required to be detailed in the report. The following information is included to provide an overall perspective of how risks and issues are managed within Defence and the selected Major Projects.

1.69 Risk management has been a focus of the MPR since its inception. The CASG risk management environment consists of multiple policies and varying implementation mechanisms and documentation. There are multiple group-level (i.e. CASG), sub-group (i.e. Divisional) and project-level risk management documents. The primary focus of the ANAO’s examination of risk management is at the project level, to conduct its review of the PDSSs. At the Group level, the Deputy Secretary CASG issued a directive in May 2017 establishing a CASG Risk Management Reform Program to implement a risk management model within Defence’s risk management framework.

1.70 In June 2020 the Deputy Secretary CASG issued a directive establishing the CASG Risk Management Framework, which is the key deliverable of the CASG Risk Management Reform Program. The initiative includes:

  • the framework, which is the primary policy and operating framework for the management of risk across the group; and
  • the Group Risk Management Strategy 2020–22, which provides a structured pathway to implementing the remodelled approach to managing risk across the 2020–22 period.

1.71 The reform was initially planned to be concluded in June 2019. Defence concluded the contract with its industry partner in May 2020. Defence advised the ANAO in November 2020 that it had delivered all three phases of the reform, including the development of risk management policies and toolsets for use by projects. However, Risk Profiles for some CASG Domains remain in draft, and Risk Management Implementation Plans are still being updated. Further, as detailed in Table 7, on p.34, not all projects are using the mandated risk management software tool, Predict!.86

1.72 Defence advised the ANAO in October 2021 that it had released tools to standardise risk practices across CASG, and that this includes the rollout of Predict! across CASG. Defence anticipates the rollout of these tools and risk practices to be completed by February 2022, which will conclude the third and final phase of the CASG Risk Reform as initially planned in the CASG Deputy Secretary’s Directive of 2017.

1.73 The ANAO will continue to monitor implementation of the Risk Management Framework, however, it will not be able to consider including risks and issues in the scope of the MPR until implementation of the framework is more mature.

1.74 In 2020–21, the ANAO again examined project offices’ risk and issue logs at the Group and Service level, which are predominantly created and maintained utilising spreadsheets and/or Predict! software. The key issues with risk management, as observed by the ANAO, related to:

  • variable compliance with corporate guidance. While most of the 21 MPR projects had an approved Risk Management Plan, only the SRGB Air Defence and Collins Comms and EW projects have updated their risk management plan within six months as required by PRMM version 2.587;
  • the visibility of risks and issues when a project is transitioning to sustainment;
  • for one project (Joint Strike Fighter), acquisition and sustainment risks are managed together88;
  • the frequency with which risk and issue logs are reviewed to ensure risks and issues are accurate and complete, appropriately managed in a timely manner, and accurately reported to senior management;
  • lack of quality control resulting in inconsistent approaches in the recording of issues within Predict!;
  • lack of a clear link between allocations against risk in the contingency log and risk logs; and
  • risk management logs and supporting documentation of variable quality, particularly where spreadsheets are being used.

1.75 The ANAO has previously observed that Defence’s use of spreadsheets as a primary form of record for risk management is a high-risk approach. Spreadsheets lack formalised change/version control and reporting, thereby increasing the risk of error. This can make spreadsheets unreliable corporate data handling tools as accidental or deliberate changes can be made to formulae and data, without there being a record of when, by whom, and what change was made. A significant amount of quality assurance is necessary to obtain confidence that spreadsheets are complete and accurate at 30 June, which is not an efficient approach to the review.

1.76 The JCPAA recommended in September 2018 that Defence plan and report a methodology to the JCPAA showing how acquisition projects can transition from the use of spreadsheet risk registers to tools with better version control.89 In response, Defence advised the JCPAA in May 2020 that Predict! will be mandated as the risk management system.90 Defence advised the ANAO in October 2021 that Defence policy was updated in August 2021 to mandate that risks must be documented in Predict!.

1.77 In October 2021 Defence further advised the ANAO that as at 30 June, 14 of the 21 MPR projects91 have a presence in Predict!, but are not necessarily using it to manage risks and issues. The ANAO’s review of documentation relating to CASG’s 21 project offices indicates that as at 30 June 2021:

  • fourteen utilised Predict!;
  • six utilised spreadsheets as their primary risk management tool;
  • two (Joint Strike Fighter and CMATS) utilised a bespoke SharePoint based tool; and
  • one (Future Frigates) used Predict! and Defence’s CapabilityOne.

1.78 Table 7 below lists the MPR projects’ use of the Predict! Risk Management System tool.

Table 7: MPR projects’ use of Predict! Risk Management System as at 30 June 2021

Project

Predict! Use

Other Risk System in Use

Joint Strike Fighter

Yes

MS SharePoint

Future Frigates

Yes

CapabilityOne

Future Subs

Yes

Combat Recon. Vehicles

Yes

MRH90 Helicopters

No

MS Excel

Offshore Patrol Vessels

Yes

Overlander Medium/Heavy

Yes

MQ-4C Triton

Yes

Hawkei

Yes

Light Tactical Fixed Wing1

No

MS Excel

SRGB Air Defence

Yes

JORN Upgrade

Yes

Repl Replenishment Ships

Yes

CMATS

No

MS SharePoint

Battlefield Command System

No

MS Excel

Battle Comm. Sys. (Land) 2B

No

MS Excel

Collins Comms and EW

No

MS Excel

Pacific Patrol Boat Repl

Yes

Maritime Comms

Yes

ANZAC Air Search Radar Repl

Yes

UHF SATCOM

No

MS Excel

Note 1: Light Tactical Fixed Wing was previously called Battlefield Airlifter.

Source: ANAO

1.79 Defence advised the ANAO that CASG has an approved rollout plan to transition all CASG projects to Predict! by February 2022.

1.80 Implementation of Predict! is expected to improve the efficiency of Defence’s risk management, standardise reporting, and improve the reliability of supporting evidence for the annual MPR.

Lessons learned

1.81 In May 2020, CASG released a revised version of its Lessons Program Policy. The Policy is underpinned by a Defence Joint Directive which directs all ‘Groups and Services, as required, to establish and lead a whole-of-Defence Joint Lessons that provides centralised Lessons management and coordination’.

1.82 Version 2.0 of the CASG Lessons Program Policy states that the:

Deputy Secretary CASG expects the CASG leadership to share best practices and lessons. To facilitate this the CASG Lessons Program continually analyses lessons collected from programs, projects, products and governance review outcomes; and ensures they are readily available via the Defence Lessons Repository (DLR).92

1.83 Defence is yet to fully implement a lessons learned framework and compliance monitoring process. The ANAO has observed that not all project lessons are available within the Defence Lessons Repository. Full implementation is expected to enable projects to review and apply lessons learned that are applicable to enable more consistent and improved project outcomes. The ANAO will continue to monitor Defence’s progress in implementing the lessons learned process for projects’ use and provide an update in the 2021–22 MPR.

Caveats and deficiencies

1.84 Defence has not defined, in its internal policies and procedures, the terms ‘caveat’ or ‘deficiency’ relating to the declaration of significant capability milestones. In November 2021, Defence advised the ANAO that caveats or deficiencies are used where a milestone (IMR, IOC, FMR, or FOC) has been achieved in principle, with outstanding actions to be rectified or mitigated.

1.85 The ANAO first observed the declaration of a major milestone with caveats in 2013–14, and Defence has continued to declare major milestones with caveats since then. In the 2017–18 MPR the ANAO noted advice from Defence that it discourages IARs recommending caveats at FOC.93

1.86 In 2020–21, Defence declared the following caveats or deficiencies relating to projects in the MPR:

  • Joint Strike Fighter — Defence declared IOC on 28 December 2020, acknowledging a number of known acceptable deficiencies with the aircraft and support systems, including some delays to weapons delivery and integration;
  • Combat Recon Vehicles — Defence declared IMR in June 2021 with three exceptions relating to the integration of electronic counter measures, the completion of Functional Configuration Audit and Physical Configuration Audit, and transportability studies including air transportability and integration with other Army vehicles; and
  • ANZAC Air Search Radar Repl — Defence declared IMR 1 in December 2020 with three caveats, and IMR 2 in April 2021 with four caveats. Of those, three caveats had been resolved by 30 June 2021.

2. Analysis of Project Performance

2.1 Performance information is important in the management and delivery of major defence equipment acquisition projects (Major Projects). It informs decisions about the allocation of resources, supports advice to government, and enables stakeholders to assess project progress.

2.2 Project performance has been the subject of many of the reviews of the Department of Defence (Defence), and a consistent area of focus of the Parliament’s Joint Committee of Public Accounts and Audit (JCPAA) since the first Major Projects Report (MPR). This chapter progresses previous Australian National Audit Office (ANAO) analysis of project performance.

Project performance analysis by the ANAO

2.3 The major dimensions of project performance are:

  • cost performance (discussed at pp.37–48) — this includes the percentage of budget expended (Budget Expended), changes in budget since Second Pass Approval, in-year changes to budget, and in-year expenditure;
  • schedule performance (discussed at pp.49–65) — this includes the percentage of time elapsed (Time Elapsed), total schedule slippage, and in-year changes to schedule; and
  • capability performance (discussed at pp.69–74) — this includes the key challenges faced by Defence in the delivery of key materiel capabilities.

2.4 This chapter provides ANAO analysis relating to the three principal dimensions of project performance noted above, drawing on the Defence Project Data Summary Sheets (PDSSs) for the 21 Major Projects. This work includes analysis of in-year information, longitudinal analysis and analysis of the results of project progress for the year-ended 30 June 2021.

2.5 Figure 1, on p.38, directly compares cost performance with schedule performance through two metrics, Budget Expended and Time Elapsed.94

Figure 1: Budget Expended and Time Elapsed at 30 June 2021

A bar chart showing budget expended and time elapsed on major projects.

Note 1: At 30 June 2021, Future Frigates and Future Subs did not have Final Operational Capability (FOC) milestones approved by government.

Note 2: JORN Upgrade FOC forecast is disclosed in its PDSS as ‘TBA’.

Source: ANAO analysis of the 2020–21 PDSSs.

2.6 Figure 1 shows that for most projects (17 of 1895), Budget Expended was broadly in line with (within 10 per cent), or lagging, Time Elapsed. This relationship is generally expected in an acquisition environment predominantly based on milestone payments. However, due to the varying complexity, stages and acquisition approaches across the portfolio of projects, further analysis of these simple performance measures is required to provide a better understanding of key variances.

2.7 Where Budget Expended is significantly lagging Time Elapsed, the project schedule may be at risk — i.e. expenditure lags may indicate delays in milestone achievement. In 2020–21, the Budget Expended for two projects lagged Time Elapsed by at least 20 per cent. These were Light Tactical Fixed Wing and Joint Strike Fighter.

2.8 For Light Tactical Fixed Wing (Budget Expended 66 per cent, Time Elapsed 90 per cent), the expenditure lag is associated with project deliverables not yet on contract, a reduction in project scope without a corresponding reduction in budget, and the planned delivery of some requirements after Final Operational Capability (FOC). In 2020 the government agreed to an operational capability ‘pivot’ from Battlefield Airlifter to Light Tactical Fixed Wing, and to re-scoping and rescheduling activities resulting in an updated Materiel Acquisition Agreement (MAA). The revised FOC is anticipated to be achieved in 2021–22.

2.9 For Joint Strike Fighter (Budget Expended 58 per cent, Time Elapsed 82 per cent), the expenditure lag continues to reflect the transition from the aircraft development stage to the production stage, where relatively little budget was expended. In-year expenditure is increasing compared to prior years, with the gap between Budget Expended and Time Elapsed being 12 percentage points smaller than in 2019–20.

2.10 Where Budget Expended leads Time Elapsed, the project budget may be at risk — i.e. expenditure increases may indicate real cost increases. However, for the one project (ANZAC Air Search Radar Repl) where Budget Expended leads Time Elapsed by 10 per cent or more, the cause of the variance does not relate to insufficient project funds.

2.11 ANZAC Air Search Radar Repl (Budget Expended 75 per cent, Time Elapsed 57 per cent) spent approximately nine per cent of its budget prior to Second Pass government approval, to conduct a Risk Reduction Program and make early purchases of equipment to ensure the schedule would be met.96

2.12 In each case of significant variance between Budget Expended and Time Elapsed, the performance information highlights projects that may require further attention. This is to ensure that unspent funds are returned to the Defence budget for re-allocation in a timely manner, the timing of key deliverables remains in focus, or planning focuses on bringing together all elements in a timely manner, as equipment is delivered.

Cost performance analysis

Approved budget at initial Second Pass Approval and at 30 June 2021

2.13 Figure 2, on pg.40, compares each project’s approved budget at initial Second Pass Approval and its approved budget at 30 June 2021. Four projects had variations of $500 million or more, with the following components:

  • Joint Strike Fighter — net increase of $12.9 billion, comprising $10.5 billion for 58 additional aircraft in 2013–14, $2.0 billion for exchange rate variation and $0.4 billion for price indexation;
  • MRH90 Helicopters — net increase of $2.8 billion, comprising $2.6 billion for 34 additional aircraft in 2005–06 and other minor scope changes, and $0.7 billion for price indexation, offset by a $0.3 billion decrease due to scope transfers for facilities, and a $0.1 billion decrease for exchange rate variation;
  • Overlander Medium/Heavy — net increase of $0.8 billion, comprising $0.7 billion ‘project supplementation’ to reduce cost pressures and $0.1 billion exchange rate variation; and
  • MQ-4C Triton — net increase of $1.0 billion, comprising $0.3 billion for an extra air vehicle in 2019–20, $0.8 billion for an additional air vehicle and interim support services for the first seven years in 2020–21, offset by a $0.1 billion decrease in exchange rate variation.

Figure 2: Approved project budgets at initial Second Pass Approval and at 30 June 2021 ($ million)

A bar chart showing the second pass approved budget and the change from second pass approved budget to 30 June 2021 approved budget.

Note 1: 

This icon features in Figure 2.

 indicates that the budget for the project at 30 June 2021 is less than the original budgeted cost.

Source: ANAO analysis of the 2020–21 PDSSs. Previous MPRs have reported that budget variances since initial Second Pass Approval have resulted from: increasing the scope of a project via revised Second Pass Approvals, programmatic decisions, Real Cost Increases/Decreases, transfers to/from other projects, and budgetary adjustments. Project budgets may also be affected by price indexation97 and foreign exchange variation.

2.14 The total budget for the 21 MPR projects at 30 June 2021 was $58.0 billion, a net increase of $18.3 billion when compared to the approved budget at initial Second Pass Approval of $39.8 billion. A summary of budget variations is at Table 2, on p.10, and a more detailed analysis of these budget variations is included in Table 8, pp.42–45.

Table 8: Budget variations post initial Second Pass Approval by variation type as at 30 June 2021, and ANAO performance audits relating to Major Projects1

Project

Budget at initial Second Pass Approval ($m)

Variation type

Explanation of variation

Year/s of variation

Variation amount ($m)

ANAO performance audits

AIR 6000 Phase 2A/2B New Air Combat Capability 2

,751.6

(Stage 1)

Scope increase/Budgetary Adjustments/Transfer

58 additional aircraft (Stage 2 Second Pass Approval) offset by minor transfers

2013–14

2017–18

10,504.1

Auditor-General Report No.14 2018–19: Joint Strike Fighter — introduction into service and sustainment planning

Auditor-General Report No.6 2012–13: Management of Australia’s Air Combat Capability – F-35A Joint Strike Fighter Acquisition

SEA 5000 Phase 1 Future Frigates

6183.9

Budget transfer

Funding transfer to Estate and Infrastructure Group to address funding shortfall with the Naval Capability Infrastructure Subprogram

2019–20

3.3

Auditor-General Report No.39 2017–18: Naval Construction Programs – Mobilisation

SEA 1000 Phase 1B Future Submarines Design Acquisition

5952.5

Budget transfer

Transfer to the Chief Information Officer Group component of SEA1000 Phase 1B for the Defence Secret Environment – International, Public Debt Interest and out-turning

2019–20

2020–21

(16.6)

Auditor-General Report No.48 2016–17: Future Submarine – Competitive Evaluation Process

Auditor-General Report No.39 2017–18: Naval Construction Programs – Mobilisation

Auditor-General Report No.22 2019–20: Future Submarine Program – Transition to Design

LAND 400 Phase 2 Combat Reconnaissance Vehicles

5762.7

N/A

N/A

N/A

0.0

Auditor-General Report No.18 2020–21: Defence’s Procurement of Combat Reconnaissance Vehicles (LAND 400 Phase 2)

AIR 9000 Phase 2/4/6 Multi-Role Helicopter

957.2

(Phase 2)

Scope increase/Budget transfers

34 additional aircraft (Phase 4/6 Second Pass Approval), offset by minor transfers

2005–06

2018–19

2,270.5

Auditor-General Report No.9 2015–16: Test and Evaluation of Major Defence Equipment Acquisitions (paragraph 4.54)

Auditor-General Report No.52 2013–14: Multi-Role Helicopter Program

Auditor-General Report No.57 2010–11: Acceptance into Service of Navy Capability

SEA 1180 Phase 1 Offshore Patrol Vessel

3639.1

N/A

N/A

N/A

0.0

Auditor-General Report No.39 2017–18: Naval Construction Programs – Mobilisation

Auditor-General Report No.12 2020–21: Defence’s Procurement of Offshore Patrol Vessels – SEA 1180 Phase 1

LAND 121 Phase 3B Medium Heavy Capability, Field Vehicles, Modules and Trailers 3

2549.2

Real Cost Increase 3 /Scope/Budgetary

adjustment

Project supplementation ($684.2m) and additional vehicles, trailers and equipment ($28.0m) at Revised Second Pass Approval

Budgetary Adjustment

(-$30.0m)

2013–14

2018–19

682.2

Auditor-General Report No.52 2014–15: Australian Defence Force’s Medium and Heavy Vehicle Fleet Replacement (LAND 121 Phase 3B)

AIR 7000 Phase 1B Multi-mission Unmanned Aircraft System

923.6

Scope increase/Budget Transfer/Real cost decrease

1 additional aircraft at Second Pass Approval – Tranche 2, minor transfers from DSTG offset by a Force Structure Plan amendment, Second Pass Approval Tranche 3 (1 Additional aircraft) and Tranche 4 (sustainment funding for first 7 years).

2017–18

2018–19

2019–20

2020–21

1,144.2

N/A

LAND 121 Phase 4 Protected Mobility Vehicle – Light

1945.0

N/A

N/A

N/A

0.0

Auditor-General Report No. 6 2018–19: Army’s Protected Mobility Vehicle – Light

AIR 8000 Phase 2 Battlefield Airlift – Caribou Replacement

1156.5

Budget transfer

Transfer to Defence Science and Technology Group

2019–20

(1.0)

Auditor-General Report No.3 2013–14: AIR 8000 Phase 2 – C- 27J Spartan Battlefield Airlift Aircraft

AIR 2025 Phase 6 Jindalee Operational Radar Network

1117.9

Scope increase/Budget Transfer

Transfer for replacing Radar 3 facility and early access to funding for early planning and de-risking activities

2020–21

10.7

Auditor-General Report No. 28 1995–96: Jindalee Operational Radar Network

Auditor-General Report No. 30 2001–2002: Test and Evaluation of Major Defence Equipment Acquisitions

Auditor-General Report No. 24 2005–06: Acceptance, Maintenance and Support Management of the JORN System

SEA 1654 Phase 3

Maritime Operational Support Capability

1004.6

Budget Transfers

Transfer for training and additional expected costs and Contract Change Proposals

2015–16

2018–19

2019–20

81.4

N/A

AIR 5341 Phase 3 Civil Military Air Management System

731.4

Real Cost Increase/ Budgetary Adjustment

Real Cost Increase offset by minor transfers

2017–18

240.7

Auditor-General Report No.4 2019–20: OneSky: Contractual Arrangements

Auditor-General Report No.46 2016–17: Conduct of the OneSKY Tender

Auditor-General Report No.1 2016–17: Procurement of the International Centre for Complex Project Management to Assist on the OneSKY Australia Program

LAND 200 Tranche 2

Battlefield Command System

930.0

N/A

N/A

N/A

0.0

Auditor-General Report No.40 2018–19: Modernising Army Command and Control – the Land 200 Program

SEA 1439 Phase 5B2

Collins Class Communications and Electronic Warfare Improvement Program

247.7 (Stage 1)

Scope increase/Budgetary Adjustment

Additional capability (Stage 2 Second Pass Approval)

2016–17

2020–21

354.0

Auditor-General Report No.23 2008–09: Management of the Collins-class Operations Sustainment

SEA 1442 Phase 4 Maritime Communications Modernisation

385.7

N/A

N/A

N/A

0.0

Auditor-General Report No.30 2018–19: ANZAC Class Frigates - Sustainment

SEA 1448 Phase 4B

ANZAC Air Search Radar Replacement

427.8

N/A

N/A

N/A

0.0

Auditor-General Report No.30 2018–19: ANZAC Class Frigates - Sustainment

JP 2008 Phase 5A Indian Ocean Region UHF SATCOM

460.9

Real Cost Decrease

Real Cost Decrease

2013–14

(18.0)

N/A

Note 1: Some projects have multiple Second Pass Approvals. This table reports on variations since the first, i.e. initial, Second Pass Approval.

Note 2: Projects that have had no Real Variations to their budget, and have not appeared in any performance audits, do not appear in this table. They are: SRGB Air Defence, Battle Comm. Sys. (Land) 2B and Pacific Patrol Boat Repl. For a definition of ‘Real Variations’ see the 2020–21 MPR Guidelines in Part 4 of this report.

Note 3: Described by Defence as ‘project supplementation’. Refer to Note 3 of Table 2.

Budget performance

2.15 The following figures and tables illustrate the budget performance of the 21 selected projects by way of:

  • in-year budget variations by project (see Table 9, on p.47); and
  • expenditure forecasting performance against actual expenditure for 2020–21 (see Figure 3 on p.49).
In-year budget variance analysis

2.16 Table 9, on p.47, sets out the in-year budget variations for each project. Overall, the approved budget for the selected projects as at 30 June 2021 decreased by $985.2 million (a 1.7 per cent decrease) compared to their approved budget as at 30 June 2020. This was driven by exchange rate variation decreases of $1808.5 million and net real increases of $822.9 million.

2.17 Exchange rate variations result from a project’s exposure to foreign currencies and movements in exchange rates against the Australian dollar.98 Budget adjustments aim to maintain the relative buying power of the project budget. Movements in the United States dollar and the Euro were the main influences. Projects with larger movements in foreign exchange in 2020–21 included:

  • Joint Strike Fighter — movement of minus $1000.6 million, or 0.6 per cent decrease in budget.
  • Future Frigates — movement of minus $245.0 million, or 3.9 per cent decrease in budget.
  • MQ-4C Triton — movement of minus $182.0 million, or 1.0 per cent decrease in budget.
  • Combat Recon. Vehicles — movement of minus $106.3 million, or 1.8 per cent decrease in budget.

2.18 Real Variations99 primarily reflect changes in the scope of projects, transfers between projects for approved equipment/capability and budgetary adjustments such as administrative savings decisions. In 2020–21 there was one project with a significant Real Variation:

  • MQ-4C Triton — variation of $823.9 million reflecting budget transfers for Second Pass Approval for Tranche 3 (providing for one additional aircraft) and Tranche 4 (providing sustainment funding for the first 7 years).

Table 9: In-year (2020–21) budget variations by project

Project

Approved Budget 2019–20 $m

Approved Budget 2020–21 $m

In-year Exchange Variation $m

In-year Real Variation $m

Total Variance $m

Total Variance (per cent)

Joint Strike Fighter

16,631.3

15,630.7

(1000.6)

0.0

(1000.6)

(6.0)

Future Frigates

6291.8

6046.9

(245.0)

0.0

(244.9)

(3.9)

Future Subs1

5925.8

5818.2

(93.5)

(14.2)

(107.6)

(1.8)

Combat Recon Vehicles

5761.7

5655.4

(106.3)

0.0

(106.3)

(1.8)

MRH90 Helicopters

3773.9

3770.0

(3.8)

0.0

(3.9)

(0.1)

Offshore Patrol Vessel

3701.4

3669.6

(31.8)

0.0

(31.8)

(0.9)

Overlander Medium/Heavy

3398.6

3397.8

(0.8)

0.0

(0.8)

0.0

MQ-4C Triton1

1311.4

1953.4

(182.0)

823.9

642.0

49.0

Hawkei

1987.5

1952.9

(34.6)

0.0

(34.6)

(1.7)

Light Tactical Fixed Wing2

1439.2

1426.1

(13.2)

0.0

(13.1)

(0.9)

SRGB Defence

1201.0

(62.8)

0.0

(73.4)

(6.1)

JORN Upgrade

1128.6

0.0

10.7

10.7

0.9

Repl Replenishment Ships

1084.7

1082.6

(2.1)

0.0

(2.1)

(0.2)

CMATS

975.6

974.5

(1.1)

0.0

(1.1)

(0.1)

Battlefield Command System

969.7

962.3

(7.3)

0.0

(7.4)

(0.8)

Battle Comm. Sys. (Land) 2B

947.1

942.2

(4.9)

0.0

(4.9)

(0.5)

Collins Comms and EW

610.7

608.7

(4.5)

2.5

(2.0)

(0.3)

Pacific Patrol Boat Repl

504.3

501.4

(2.9)

0.0

(2.9)

(0.6)

Maritime Comms

444.0

434.1

(10.0)

0.0

(9.9)

(2.2)

ANZAC Air Search Radar Repl

429.4

429.1

(0.3)

0.0

(0.3)

(0.1)

UHF SATCOM

422.1

421.3

(0.9)

0.0

(0.8)

(0.2)

Total3

56,610.2

58,006.8

(1808.5)

822.9

(985.2)

(1.7)

Note 1: The Total Variance and components for this project do not add up due to rounding differences.

Note 2: Previously referred to as Battlefield Airlifter.

Note 3: The difference between the total approved budgets for 2019–20 and 2020–21 is due to the projects entering the MPR in 2020–21 (SRGB Air Defence and JORN Upgrade) not contributing to the total budget figure for 2019–20).

Source: ANAO analysis of the 2019–20 and 2020–21 PDSSs.

In-year forecast and actual expenditure

2.19 Accurately forecasting and managing budget expenditure is an important element in the management of a portfolio of projects. Figure 3, on p.49, sets out the expenditure forecasting performance of each project against actual expenditure in 2020–21. In total, actual expenditure for the 21 Major Projects at 30 June 2021 was $6120.4 million. This is compared against an initial Portfolio Budget Statements (PBS) forecast expenditure of $6853.0 million, a mid-year Portfolio Additional Estimates Statements (PAES) forecast of $6396.0 million, and a final forecast of $6218.5 million (Final Plan, approved as at June 2021).

2.20 The Defence PDSSs report that the variances illustrated in Figure 3 reflect the following developments:

  • Joint Strike Fighter (expenditure of $2565.9 million compared to $2430.6 million PBS, $2354.4 million PAES and $2252.9 million Final Plan estimates) — the overspend is attributed to early achievement of cooperative program deliverables associated with the air vehicle and engine.
  • Future Frigates (expenditure of $508.5 million compared to $587.0 million PBS, $506.9 million PAES and $498.4 million Final Plan estimates) — the underspend is reported as reflecting reprogramming of activities against the Head Contract.
  • Future Subs (expenditure of $630.8 million compared to $782.5 million PBS, $782.2 million PAES and $768.3 million Final Plan estimates) — the underspend is predominantly attributed to not entering the next contracted work scope as initially forecast with Naval Group, and Lockheed Martin Australia not achieving the Commonwealth’s expected labour levels. There was also lower than anticipated expenditure against other contractor support.
  • Combat Recon. Vehicles (expenditure of $414.6 million compared to $566.1 million PBS, $501.4 million PAES and $488.7 million Final Plan estimates) — the underspend is reported as reflecting later than expected achievement of milestones due to technical difficulties and delays in the global Boxer program, some of which are a result of COVID-19 impacts on the supply chain and travel restrictions.
  • Offshore Patrol Vessel (expenditure of $204.6 million compared to $285.1 million PBS, $249.2 million PAES and $248.9 million Final Plan estimates) — the underspend is reported as reflecting schedule delays as a result of COVID-19 in achieving contractual milestones and underspend on Project Office costs and government furnished equipment.
  • Repl Replenishment Ships (expenditure of $150.4 million compared to $231.3 million PBS, $254.5 million PAES and $252.1 million Final Plan estimates) — the underspend is reported as reflecting the transfer of additional works from Spain to Australia and contract change proposal delays for final sparing deliveries.
  • Battlefield Command System (expenditure of $67.5 million compared to $216.5 million PBS, $118.5 million PAES and $116.6 million Final Plan estimates) — the underspend is reported as reflecting the finalisation of a number of contract change proposals which updated the payment and delivery schedules for Battle Management System (BMS) and Tactical Communications Network (TCH) prime contracts and the inability to achieve the exit criteria for the Release 1.1 Software Release Review milestone.

Figure 3: In-year (2020–21) projects’ forecast expenditure performance compared to actual expenditure ($m)

A bar chart that shows various forecast expenditures of the major projects.

Sources: ANAO analysis of the 2020–21 PDSSs and Defence Portfolio Budget Statements.

Schedule performance analysis

2.21 Defence data continues to show that schedule performance is a key issue in delivering and sustaining Defence equipment and capability.100 Project schedule slippage can have the effect of introducing or exacerbating a capability gap or requiring an extension to the planned withdrawal date for those platforms being replaced.101

Schedule slippage and acquisition type by approval date

2.22 The ANAO compares project slippage against the classification of projects as Military Off-The-Shelf (MOTS), Australianised MOTS, or developmental, as these classifications are a general indicator of the difficulty associated with the procurement process.102 Prima facie, the more developmental in nature a project is, the greater the schedule risk and therefore the greater the need for more robust planning by Defence.103,104

2.23 In 2020–21 the acquisition type, or classification, is no longer reported in the PDSS Header for the selected Major Projects. Project complexity is instead indicated by the Acquisition Categorisation (ACAT) level. Projects are graded into one of four (ACAT) acquisition categories105:

  • ACAT I — major capital equipment acquisitions that are normally the Australian Defence Force’s (ADF) most strategically significant. They are characterised by extensive project and schedule management complexity and very high levels of technical difficulty, operating, support and commercial arrangements.
  • ACAT II — major capital equipment acquisitions that are strategically significant. They are characterised by significant project and schedule management and high levels of technical difficulty, operating, support arrangements and commercial arrangements.
  • ACAT III — major or minor capital equipment acquisitions that have a moderate strategic significance to the ADF. They are characterised by the application of traditional project and schedule management techniques and moderate levels of technical difficulty, operating, support arrangements and commercial arrangements.
  • ACAT IV — major or minor capital equipment acquisitions that have a lower level of strategic significance to the ADF. They are characterised by traditional project and schedule management requirements and lower levels of technical difficulty, operating, support and commercial arrangements.

2.24 This year, the ANAO has continued its longitudinal analysis based on acquisition type (MOTS, Australianised MOTS and developmental) to provide a transition to analysis based on ACAT levels.

ANAO analysis based on project acquisition type and acquisition category level

2.25 Table 10, below, provides information on the acquisition type and ACAT level of all 56 Major Projects included in the MPR since its inception, and the year of approval (generally Second Pass) for each Major Project.

2.26 In relation to the acquisition type for the 56 Major Projects, Table 10 indicates that:

  • 14 projects (25 per cent) were developmental;
  • 26 projects (46 per cent) were Australianised MOTS; and
  • 16 projects (29 per cent) were MOTS.

2.27 In relation to the acquisition category for the 56 Major Projects, Table 10 indicates that:

  • 14 projects (25 per cent) were ACAT I;
  • 29 projects (52 per cent) were ACAT II;
  • 12 projects (21 per cent) were ACAT III; and
  • 1 project (2 per cent) was ACAT IV.

Table 10: Project year of approval, acquisition type and acquisition category

Project

Year of Approval

Acquisition type

Acquisition Category (ACAT)

HF Modernisation

1996

Developmental

ACAT II

Hornet Upgrade

1998

Australianised MOTS

ACAT II

Bushmaster Vehicles

1998

Australianised MOTS

ACAT III

ARH Tiger Helicopters

1999

Australianised MOTS

ACAT II

FFG Upgrade

1999

Developmental

ACAT II

Collins R&S

2000

Australianised MOTS

ACAT III

Wedgetail

2000

Developmental

ACAT I

Hw Torpedo

2001

MOTS

ACAT III

Collins RCS

2002

Australianised MOTS

ACAT IV

Armidales

2002

Australianised MOTS

ACAT III

Hornet Refurb

2003

MOTS

ACAT II

Air to Air Refuel

2003

Developmental

ACAT II

ANZAC ASMD 2A

2003

Australianised MOTS

ACAT II

SM-2 Missile

2004

Australianised MOTS

ACAT III

MRH90 Helicopters

2004

Australianised MOTS

ACAT I

ANZAC ASMD 2B

2005

Developmental

ACAT I

Stand Off Weapon

2005

Australianised MOTS

ACAT II

C-17 Heavy Airlift

2006

MOTS

ACAT III

Super Hornet

2007

MOTS

ACAT II

AWD Ships

2007

Australianised MOTS

ACAT I

LHD Ships

2007

Australianised MOTS

ACAT I

Overlander Light

2007

Australianised MOTS

ACAT II

Next Gen Satellite

2007

MOTS

ACAT II

UHF SATCOM

2009

MOTS

ACAT II

155mm Howitzer

2009

MOTS

ACAT III

Joint Strike Fighter

2009

Developmental

ACAT I

Battle Comm. Sys.

2009

Australianised MOTS

ACAT II

Additional Chinook

2010

MOTS

ACAT III

C-RAM

2010

MOTS

ACAT III

MH-60R Seahawk

2011

MOTS

ACAT II

LHD Landing Craft

2011

Australianised MOTS

ACAT III

Battle Comm. Sys. (Land) 2A

2011

MOTS

ACAT III

Light Tactical Fixed Wing

2012

MOTS

ACAT II

Growler

2013

Australianised MOTS

ACAT II

Maritime Comms

2013

Australianised MOTS

ACAT II

Overlander Medium/Heavy

2013

Australianised MOTS

ACAT I

BMS

2013

Australianised MOTS

ACAT II

P-8A Poseidon

2014

MOTS

ACAT II

HATS

2014

Australianised MOTS

ACAT II

CMATS

2014

Developmental

ACAT I

Battle Comm. Sys. (Land) 2B

2015

Developmental

ACAT I

Collins Comms and EW

2015

MOTS

ACAT II

Additional MRTT

2015

Australianised MOTS

ACAT II

Hawkei

2015

Developmental

ACAT I

Repl Replenishment Ships

2016

Australianised MOTS

ACAT II

Pacific Patrol Boat Repl

2016

MOTS

ACAT II

Night Fighting Equipment Repl

2016

MOTS

ACAT III

ANZAC Air Search Radar Repl

2017

Developmental

ACAT II

Battlefield Command System

2017

Developmental

ACAT I

Offshore Patrol Vessel

2017

Australianised MOTS

ACAT II

JORN Upgrade

2017

Developmental

ACAT II

Combat Recon. Vehicles

2018

Australianised MOTS

ACAT I

Future Frigates

2018

Australianised MOTS

ACAT I

MQ-4C Triton

2018

Developmental

ACAT I

Future Subs

2019

Developmental

ACAT I

SRGB Air Defence

2019

Australianised MOTS

ACAT I

2.28 Table 10 (above) and Figure 4 (p.54) indicate that developmental projects became less common after 2005. Based on the findings of the Defence Procurement Review 2003 (Kinnaird Review)106, in 2005 Defence began to increase the proportion of MOTS acquisitions, which are generally lower risk projects and therefore more likely to meet schedule timelines.107 Table 10 and Figure 4 also indicate a continuing trend, where developmental projects have become more common since 2014. Of the 16 Major Projects which have received government approval since 2014:

  • 7 projects (44 per cent) were developmental;
  • 6 projects (38 per cent) were Australianised MOTS; and
  • 3 projects (19 per cent) were MOTS.

2.29 Figure 5 (p.55) illustrates the proportion of ACAT I to IV projects over time. In common with Figure 4, Figure 5 indicates a continuing trend towards the approval of more complex projects at the ACAT I and II levels. Of the 16 Major Projects which have received government approval since 2014:

  • 6 projects (38 per cent) were ACAT I;
  • 9 projects (56 per cent) were ACAT II;
  • 1 project (6 per cent) was ACAT III; and
  • no projects were ACAT IV.

Figure 4: Acquisition type and year of approval

A bubble chart that shows the years that different categories of projects were approved.

Note 1: Projects to the left of the dotted line were approved prior to implementation of the Kinnaird reforms in 2005. Projects to the right were approved following the reforms being implemented.

Key: 

A small-sized bubble.
 – One project approved;
A medium-sized bubble.
 – Two projects approved;
A large-sized bubble.
 Three projects approved;
An extra-large-sized bubble.
 – Four projects approved

Figure 5: Categorisation (ACAT) type and year of approval

A bubble chart that shows the years that projects, categorised by ACAT, were approved.

Note 1: Projects to the left of the dotted line were approved prior to implementation of the Kinnaird reforms in 2005. Projects to the right were approved following the reforms being implemented.

Key: 

A small-sized bubble.
 – One project approved;
A medium-sized bubble.
– Two projects approved;
A large-sized bubble.
 – Three projects approved

Schedule slippage by acquisition type and acquisition category

2.30 The challenge of gaining a full understanding of the complexities of developmental aspects of projects at Second Pass Approval is evident by the extent of slippage over time. Figure 6, on p.58, illustrates the total schedule slippage108 since Second Pass Approval for 19 of the selected Major Projects.109 It also depicts the acquisition type and places projects in order of government approval.

2.31 Figures 7a and 7b, on pp.59–60, illustrate the total schedule slippage for the 33 projects that have exited the MPR.110 Twenty post-Kinnaird projects (Figure 7a) and 13 pre-Kinnaird projects (Figure 7b) have exited the MPR. Total slippage of the 20 post-Kinnaird projects is 37.0 years. Total slippage of the 13 pre-Kinnaird projects is 79.6 years. One of the 20 post-Kinnaird projects was a developmental acquisition and four of the 13 pre-Kinnaird acquisitions were developmental.

2.32 In relation to the 20 exited post-Kinnaird MPR projects (see Figure 9a, on p.62):

  • two were ACAT I with an average slippage of 37 months;
  • eleven were ACAT II with an average slippage of 15 months; and
  • seven were ACAT III with an average slippage of 12 months.

2.33 Of the 13 exited pre-Kinnaird MPR projects (see Figure 9b, p.63):

  • one was ACAT I with slippage of 77 months111;
  • six were ACAT II with an average slippage of 89 months;
  • five were ACAT III with an average slippage of 47 months; and
  • one was ACAT IV with slippage of 107 months.112

2.34 Figures 7a and 7b indicate that the inclusion of MOTS acquisitions contributed, prima facie, to a reduction in schedule slippage in the Major Projects portfolio. For projects that have exited the MPR, MOTS projects reported an average of 13 months of slippage per project, Australianised MOTS projects reported an average of 38 months, and developmental projects reported an average of 96 months. Decisions on whether to undertake developmental projects should be considered on a risk basis.113 In this context, the consideration of risk should be holistic and weigh up the level of capability to be acquired while having regard to Defence’s past experience in managing the delivery of developmental projects.

2.35 Figures 6, 7a and 7b also illustrate that older projects have experienced the most slippage. These projects tended to be more developmental (complex) in nature and typically experienced schedule slippage in the past and have often continued to do so. This demonstrates an ongoing trend of slippage in historically late projects, which is more pronounced in older projects. This trend is also visible, but less prominent, in newer projects.

2.36 Figure 8, on p.61, indicates that for current projects graded at the ACAT I level, there was an average of 43 months slippage. Projects at the ACAT II level experienced an average of 21 months slippage. For projects that had exited the MPR (see Figures 9a and 9b, on p.62–63):

  • ACAT I projects reported an average of 57 months slippage;
  • ACAT II projects reported an average of 42 months slippage;
  • ACAT III projects reported an average of 28 months slippage; and
  • the ACAT IV project reported 107 months slippage.114

2.37 Three developmental projects, Hawkei, JORN Upgrade, and ANZAC Air Search Radar Repl, are yet to experience slippage to their FOC dates. However, these projects have experienced slippage to design reviews, test programs, or material release milestones.

2.38 Hawkei has experienced 24 months slippage to the Production Reliability Acceptance Test, leading to 17 months slippage to Initial Materiel Release (IMR) — which was declared in May 2020 with four caveats, which have now been resolved.115 Hawkei experienced an additional six-month delay pending resolution of a vehicle safety incident and a further five month delay due to vehicle integration issues.

2.39 JORN Upgrade experienced persistent lag in execution of the systems engineering program, leading to 17 months of slippage to the System Definition Review and at least two years of slippage to the Preliminary Design Review. FOC is expected to be affected; the amount of slippage to this milestone is not yet known, but the delay is anticipated to be several years. Key drivers for the delays are predominantly attributed to the underestimation of JORN systems engineering complexity and required design effort.

2.40 ANZAC Air Search Radar Repl experienced a total of 18 months of slippage to the original definition of IMR due to delays in receiving Identification Friend or Foe certification, which was impacted by COVID-19 travel restrictions. Early project milestones have also been delayed by manufacturing delays, delays in the contractor obtaining Environmental Qualification for equipment, limited numbers of test facilities and longer than anticipated test durations.

2.41 In contrast, a recent MOTS project, Pacific Patrol Boat Repl, has adhered more closely to the design and materiel release schedule with only minor variances. This indicates that although developmental projects currently in the MPR are not reporting significantly more slippage to FOC than MOTS projects, developmental projects still carry a higher level of technical risk.

2.42 Four116 of the eight current ACAT I projects and six117 of the 11 current ACAT II projects have experienced slippage to their FOC dates. There are no ACAT III or IV projects in the 2020–21 MPR.

2.43 The average slippage for ACAT I projects in this year’s MPR is 42 months, and the average for ACAT II projects is 21 months. This indicates that ACAT I projects currently in the MPR are reporting more slippage to FOC than ACAT II projects and carry a higher level of technical risk.

Figure 6: Current Major Projects — total slippage post Second Pass approval and acquisition type by approval date (years)

A column chart showing the total slippage in years and the year of the acquisition approval.

Note 1: The order of the projects is from latest to earliest approved. All project slippage relates to FOC dates. The Future Frigates and Future Subs projects did not have government approved FOC dates at 30 June 2021.

Note 2: The JORN Upgrade project FOC forecast is disclosed in the PDSS as ‘TBA’.

Source: ANAO analysis of the PDSSs in published Major Projects Reports.

Figure 7a: Exited Major Projects (approved post-2005) — total slippage post Second Pass approval and acquisition type by approval date (years)

A column chart showing the total slippage post second pass approval and acquisition type by approval date.

Note 1: The order of the projects is from latest to earliest approved. All project slippage relates to FOC dates. The Hornet Refurb and BMS projects did not have FOC dates.

Note 2: The slippage shown for Next Gen Satellite related to the final capability milestones at the time. By the time it reached FOC, a new final capability milestone had been introduced which reduced this slippage.

Note 3: These projects were approved after the Kinnaird reforms were implemented.

Source: ANAO analysis of the PDSSs in published Major Projects Reports.

Figure 7b: Exited Major Projects (approved pre-2005) — total slippage post Second Pass approval and acquisition type by approval date (years)

A column chart showing the total slippage post second pass approval and acquisition type by approval date.

Note 1: The order of the projects is from latest to earliest approved. All project slippage relates to FOC dates. The Hornet Refurb and BMS projects did not have FOC dates.

Note 2: These projects were approved prior to the Kinnaird reforms being implemented.

Source: ANAO analysis of the PDSSs in published Major Projects Reports.

Figure 8: Current Major Projects — total slippage post Second Pass approval and ACAT rating by approval date (years)

A column chart showing the total slippage past Second pass approval and ACAT rating by approval date.

Note 1: The order of the projects is from latest to earliest approved. All project slippage relates to FOC dates. The Future Frigates and Future Subs projects did not have government approved FOC dates at 30 June 2021.

Note 2: The JORN Upgrade project FOC forecast is disclosed in the PDSS as ‘TBA’.

Source: ANAO analysis of the PDSSs in published Major Projects Reports.

Figure 9a:  Exited Major Projects (approved post-2005) — total slippage post Second Pass approval and ACAT rating by approval date (years)

A column chart showing total slippage past Second Pass approval and ACAT rating by approval date.

Note 1: The order of the projects is from latest to earliest approved. All project slippage relates to FOC dates. The Hornet Refurb and BMS projects did not have FOC dates.

Note 2: The slippage shown for Next Gen Satellite related to the final capability milestones at the time. By the time it reached FOC, a new final capability milestone had been introduced which reduced this slippage.

Note 3: These projects were approved following implementation of the Kinnaird reforms in 2005.

Source: ANAO analysis of the PDSSs in published Major Projects Reports.

Figure 9b: Exited Major Projects (approved pre-2005) — total slippage post Second Pass approval and ACAT rating by approval date (years)

A column chart showing total slippage past Second Pass approval and ACAT rating by approval date.

Note 1: The order of the projects is from latest to earliest approved. All project slippage relates to FOC dates. The Hornet Refurb and BMS projects did not have FOC dates.

Note 2: These projects were approved prior to the Kinnaird reforms being implemented.

Source: ANAO analysis of the PDSSs in published Major Projects Reports.

Schedule performance

2.44 The figures and tables that follow illustrate, for the selected Major Projects:

  • the original and 30 June 2021 forecasts for achieving FOC;
  • in-year schedule changes to achieving FOC; and
  • total schedule slippage across the Major Projects.
Original and 30 June 2021 Final Operational Capability forecasts

2.45 Figure 10, on p.65, presents information on the selected Major Projects’ original and 30 June 2021 forecasts for achieving FOC. Total schedule slippage for the 21 Major Projects as at 30 June 2021 was 405 months compared to the initial prediction when approved by government.118 This represents a 23 per cent increase on the approved schedule.

2.46 Of the 21 projects in the 2020–21 report, ten have experienced schedule slippage (not including JORN Upgrade, which discloses its FOC forecast as ‘TBA’ and expects this milestone to slip by a currently unknown magnitude, primarily due to the underestimation of JORN systems engineering complexity and required design effort) and two did not have FOC dates approved by government at 30 June 2021.

2.47 Total schedule slippage across the Major Projects was 405 months in 2020–21. This is 102 months lower than the figure of 507 months reported in the 2019–20 MPR. The difference is mainly due to the exit of projects with significant slippage — including AWD ships, P-8A Poseidon, Growler and Collins R&S — which reduced the total accumulated slippage by 175 months. This was offset by in-year slippage for MRH90 Helicopters (associated with remediation of technical difficulties and reliability issues), MQ-4C Triton (associated with changes in the planned aircraft delivery schedule), Light Tactical Fixed Wing (with Defence revalidating the business case for the delivery of this project’s remaining scope), CMATS (associated with the replanning of deliverables), and Battle Comm. Sys. (Land) 2B (as a result of COVID-19 impacts). These five projects, combined, added 73 months to schedule slippage in 2020–21.

2.48 The reasons for schedule slippage often require a deep understanding of project technical elements and a realistic assessment of the capacity of the private sector to deliver in the expected timeframe. A project office’s ability to gain access to the platform for upgrade activities can also result in schedule delay (for example, Maritime Comms).119

2.49 A closer examination of the reasons for schedule slippage demonstrates the importance of initial assessments of project complexity. Experience indicates that a key factor is whether a project is MOTS, Australianised MOTS or developmental.120 One project, MRH90 Helicopters121, was originally misclassified as MOTS. The project was reclassified by Defence to Australianised MOTS (i.e. more developmental) subsequent to Second Pass approval, and a Defence Independent Assurance Review of this project in December 2020 noted that ‘[MRH-90] was a developmental platform’. This project has continued to experience schedule slippage, with an additional six months slippage in 2020–21. Another project, UHF SATCOM, is classified as MOTS but includes a significant software development component. Delays in software development have led to 42 months of slippage to the FOC milestone, however there were no additional delays in 2020–21.

2.50 Figure 10, below, indicates that no projects are currently forecasting an FOC date earlier than originally approved. However, a number of projects have experienced both schedule recovery and delay that has offset that recovery. Projects fitting this pattern are Joint Strike Fighter, Overlander Medium/Heavy, Repl Replenishment Ships, and Collins Comms and EW. In the case of Joint Strike Fighter, Overlander Medium/Heavy, and Repl Replenishment Ships, their schedule recovery and schedule delay is equal such that all three projects are currently forecasting the achievement of FOC as originally approved by government. In total, these four projects have contributed 28 months of schedule recovery to the selected Major Projects.

Figure 10: Projects’ original and 30 June 2021 Final Operational Capability forecasts

A bar chart showing the projects’ original and 30 June 2021 final operational capability forecasts.

Note 1: Future Frigates and Future Subs did not have government approved FOC dates at 30 June 2021. The JORN Upgrade and CMATS FOC forecasts are disclosed in their PDSSs as ‘TBA’.

Source: ANAO analysis of the 2020–21 PDSSs.

In-year schedule performance

2.51 In 2020–21, there was schedule slippage of 73 months in the forecast achievement of FOC across 19 of the Major Projects122, as shown in Figure 11, on p.67. In-year project performance, measured by slippage over 12 months, may not reflect the project trend.

2.52 In-year schedule slippage occurred for the following five projects123:

  • MRH90 Helicopters — the variance reflects ongoing delays in the delivery of capabilities resulting from technical deficiencies and issues resulting from replacement or re-design.
  • MQ-4C Triton — the variance reflects the alignment of the project’s FOC schedule with the aircraft production schedule.
  • Light Tactical Fixed Wing — FOC has been delayed while Defence re-evaluates the business case for delivery of this project’s remaining capability.
  • CMATS — FOC is disclosed in the PDSS as ‘TBA’ while Thales replans deliverables and the flow on impacts are assessed. The PDSS reported 13 months slippage.
  • Battle Comm. Sys. (Land) 2B — FOC has been delayed due to an extension to the project schedule as a result of COVID-19 delays.

Figure 11: In-year (2020–21) schedule changes to achieving Final Operational Capability

A bar chart showing the in-year schedule changes.

Note: Defence’s PDSSs indicate that 14 of the 19 Major Projects did not record changes to their FOC dates this year. Future Frigates and Future Subs did not have FOC dates approved by government at 30 June 2021. The JORN Upgrade and CMATS projects’ FOC forecasts are disclosed in the PDSS as ‘TBA’. The delays for the JORN Upgrade project are anticipated to be several years and CMATS has disclosed 13 months slippage in 2020‍–‍21.

Source: ANAO analysis of the 2020–21 PDSSs.

2.53 Project delays may indicate unanticipated problems with project progress or optimism in previous forecasting, regardless of whether the delay makes the project later than originally approved by government. All delays should be monitored to ensure that a project remains on track and any issues can be managed.

Schedule performance by year of entry to Major Projects Report

2.54 Table 11, on p.68, shows the accumulated schedule slippage of the Major Projects included in the 2020–21 MPR.124 The table shows that over a third of the total schedule slippage across the selected Major Projects (33.8 years or 405 months) comprises slippage from the two oldest projects, approved prior to 2010.

Table 11: Project slippage as at 30 June 2021

Project

Second Pass Approval date

No. of months between Approval and Original FOC date

No. of months between Approval and 30/6/21 FOC date

No. of months slippage between Original FOC and 30/6/21 FOC date

MRH90 Helicopters

August 2004

119

214

95

UHF SATCOM

March 2009

111

153

42

Joint Strike Fighter

November 2009

169

169

0

Light Tactical Fixed Wing

April 2012

68

122

54

Maritime Comms

July 2013

125

141

16

Overlander Medium/Heavy

July 2013

125

125

0

CMATS

December 2014

102

149

47

Battle Comm. Sys. (Land) 2B

April 2015

65

101

36

Collins Comms and EW

June 2015

114

144

30

Hawkei

August 2015

94

94

0

Repl Replenishment Ships

April 2016

80

80

0

Pacific Patrol Boat Repl

April 2016

89

91

2

ANZAC Air Search Radar Repl

June 2017

84

84

0

Battlefield Command System

September 2017

57

73

16

Offshore Patrol Vessel

November 2017

151

151

0

Combat Recon. Vehicles

March 2018

111

111

0

MQ-4C Triton

June 2018

90

157

67

SRGB Air Defence

February 2019

88

88

0

Total - all projects with slippage

1754

2159

405

Note 1: Future Frigates and Future Subs did not have FOC dates approved by government at 30 June 2021. The JORN Upgrade and CMATS projects FOC forecast is disclosed in the PDSS as ‘TBA’. The delays for the JORN Upgrade project are anticipated to be several years. CMATS has disclosed 13 months delay in 2020–21.

Source: ANAO analysis of the 2020–21 PDSSs.

Capability performance analysis

2.56 Defence defines capability as the power to achieve a desired operational effect in a nominated environment, within a specified time, and to sustain that effect for a designated period.125 An operational effect is achieved by combining the nine Fundamental Inputs to Capability — organisation, command and management, personnel, collective training, major systems, facilities and training areas, supplies, support, and industry — and undertaking designated operations.126

2.57 In acquiring Defence platforms and systems, a range of documentation (including capability definition, operational concept, function and performance specification, and Test and Evaluation Master Plans) is developed, which establishes the detailed requirements/performance attributes to be achieved.

2.58 The Defence PDSSs report that 13 projects in this year’s MPR will deliver all their key capability requirements without elevated levels of risk to the achievement of requirements.127 Defence’s assessment indicates that some elements of the capability required may be ‘under threat’, but the risk is assessed as ‘manageable’. The six project offices experiencing challenges with expected capability delivery (2019–20: five) were Joint Strike Fighter, MRH90 Helicopters, Overlander Medium/Heavy, Light Tactical Fixed Wing128, Battlefield Command System, and Battle Comms. Sys. Land (2B). Two of these projects, Light Tactical Fixed Wing and Battlefield Command System, report that they are unable to deliver all the required capability by FOC.

2.59 Table 12, below, summarises the issues reported by Defence in its PDSSs as impacting the achievement of the expected capabilities.

Table 12: Issues impacting expected material capability delivery performance in 2020‍–‍21

Project

Amber

%

Red

%

Explanation in PDSS

Joint Strike Fighter

A pie chart showing the amber and red percentages for the Joint Strike Fighter.

1

0

AIR 6000 Phase 2A/B has options to deliver Maritime Strike capabilities in a timeframe closely following that of the United States Navy. Phase 2A/B will also continue to invest in F-35A development toward advanced Maritime Strike options for consideration under AIR 3023 in the context of a Joint Maritime Strike strategy.

MRH90 Helicopters

A pie chart showing the amber and red percentages for the MRH90 Helicopters.

25

0

MRH Project Office continues to work with industry to contract, redesign and deliver outstanding role equipment including the Taipan Gun Mount, Common Mission Management System, Aero-Medical Evacuation – Mature (AME-M) capability.

Overlander Medium/Heavy

A pie chart showing the amber and red percentages for the Overlander Medium/Heavy.

11

0

IOC was achieved with caveats due to delay in achievement of air certification. Achieving air certification by FOC remains a medium risk post mitigation. Schedule management remains a key focus and is being closely managed by CASG and the Capability Manager.

Battle Comm. Sys. (Land) 2B

A pie chart showing the amber and red percentages for the Battle Comm. Sys. (Land) 2B.

3

0

The Project is managing schedule risks associated with the Terrestrial Range Extension system scope of work as expressed in the Materiel Acquisition Agreement and supporting suite of Capability Definition Documentation.

Light Tactical Fixed Wing (previously Battlefield Airlifter)

A pie chart showing the amber and red percentages for the Light Tactical Fixed Wing.

0

3

A simulator with less mission functionality will be procured and $35m is set aside for risk management of future platform obsolescence (avionics).

Battlefield Command System

A pie chart showing the amber and red percentages for the Light Tactical Fixed Wing.

0

9

Based on direction from the Army program sponsor, the project does not expect to deliver the WINBMS capability within the M1A1. Further, also based on direction from the Army program sponsor, the project does not expect to deliver the Hawkei GSV node: this is offset by the direction from the Army Program Sponsor to increase the delivered quantities of Hawkei C2V and MNV nodes. This approach is expected to be confirmed following government consideration.

Note 1: Amber indicates that the capability is under threat but considered manageable for that portion of the pie chart.

Note 2: Red indicates that the capability is unlikely to be met for that portion in the pie chart.

Source: Defence Project Data Summary Sheets (PDSS).

Capability reporting

2.60 Since the 2009–10 MPR, capability reporting129 has been based on Defence’s prediction of the final capability that would be achieved on the basis of deliverables and/or activities completed. This assessment of capability performance (Expected Capability) is measured against the Materiel Release Milestones (MRMs) and Completion Criteria specified in each project’s Materiel Acquisition Agreement (MAA). This is distinct from an assessment of whether milestones will be achieved on schedule. As the ANAO has previously noted, this data involves making certain assumptions in forecasting achievements and is therefore subjective in approach.130

2.61 For example, the Light Tactical Fixed Wing project reported a 100 per cent Green capability prediction at its inclusion in the MPR in 2013–14. However, the 2013–14 PDSS also reported major risks relating to capability deficiencies arising from the United States Government divesting from the program, with Australia no longer able to rely on United States Air Force processes. These risks have continued to affect the project, with a mature training system and a number of baseline capability requirements not expected to be delivered until after FOC. These capability issues were reported in Section 4.1 of the PDSS (Materiel Capability Delivery Performance pie chart) for the first time in 2018–19, indicating that the earlier level of confidence in the project’s ability to achieve the required capability may have been overly optimistic. In 2020 the Australian Government approved an operational capability ‘pivot’ for this project, from ‘Battlefield Airlifter’ to ‘Light Tactical Fixed Wing’. This involved re-scoping and re-scheduling activities, resulting in an updated Materiel Acquisition Agreement (MAA). The revised FOC is anticipated to be achieved in 2021–22. Notwithstanding the ‘pivot’ relating to this project, which represents a substantive change in capability delivery, the Materiel Capability Delivery Performance pie chart in this year’s PDSS includes a slim red wedge representing a three per cent reduction in capability delivery.

2.62 Defence does not have a standard methodology for the assessment of capability delivery performance. A combination of methods is used, including an assessment based on the proportion of overall cost for each milestone, or the percentage the milestone represents with respect to the overall capability. Defence’s approach to assessment does not include weighting of the elements of capability, which affects the effectiveness of its reporting.

2.63 Over time, the JCPAA has sought the use of a more robust measure of capability performance.131 In October 2017, the JCPAA recommended that Defence ‘review the procedure for the development of expected capability estimates for future Major Projects Reports. The outcomes of this review should be provided to the Committee within six months of the tabling of this report. Further, the Committee requests that Defence provide a progress report within three months of the tabling of this report.’132

2.64 Defence made a submission to the JCPAA in March 2018 regarding the JCPAA recommendation, which advised that:

Defence will conduct a schedule baseline validation activity for the Major Projects Report projects to drive greater consistency in schedule reporting.

Once this activity is complete, Defence should be in a better position to investigate a more robust approach to measuring Capability estimates. Utilising the validated baseline data could inform:

  • A simple percentage of schedule milestones achieved to measure progress to date. This is a quantitative assessment that relies on the maintenance of a robust project baseline, which is not dissimilar to the approach proposed by ANAO previously;
  • CASG working with Force Design to identify how to measure capability, that considers all elements of Fundamental Inputs to Capability, and that is suitable for unclassified publication; and
  • Defence is working towards a new whole of organisational reporting system (the Enterprise Resource Planning (ERP) System) which is expected to roll-out in Financial Year 2020–21. CASG will endeavour to incorporate the work conducted with Force Design on measuring capability.133

2.65 In September 2018, the JCPAA noted that ‘Materiel Capability Delivery Performance charts continue to be ambiguous in displaying actual current capability levels.’134

2.66 Defence advised the ANAO in November 2018 that partial progress had been made on its schedule baseline validation activity discussed in paragraph 2.63. The ANAO notes that a measurement of schedule milestones will not necessarily reflect a measurement of capability delivered.

2.67 The Deputy Secretary CASG advised the JCPAA in a public hearing on 27 May 2020 that:

I acknowledge the issues of the National Audit Office and would like to work with them, as we indicated in our submission, by perhaps reviewing the report and the way in which we articulate the information.135

2.68 As at November 2021, Defence was yet to update the method of capability forecasting in the MPR.

Transfers of project scope

2.69 As part of Second Pass Approval, government directs Defence projects to deliver certain defined capabilities within the scope of the project. During a project, Defence may change the scope to be delivered, which can be approved through a revised government approval. A project’s scope may be expanded or reduced and may include a budget increase or decrease for the project to deliver its revised requirements.

2.70 The 2020–21 MPR Guidelines require information on all scope transfers that have occurred across the current Major Projects to be reported in Section 1.3 of the PDSS. These transfers are described in Table 13, below.

2.71 A variety of transfers were also reported by Defence in Section 2.1 of some PDSSs, either as ‘Real Variation – Transfer’ or ‘Real Variation – Scope’. Explanatory notes relating to Section 2.1 indicated that project deliverables, and associated funding, had been transferred into or out of the relevant project.136 These transfers are also described in Table 13.

Table 13: Examples of transfers of scope occurring in the Major Projects as at 30 June 2021

Project

Year of transfer

Description

Joint Strike Fighter1

2018

Project scope worth $1.5bn was transferred to future (unapproved) phases of the AIR6000 program, with no corresponding transfer of funds out of the project budget.

Future Subs

2020

Project scope worth $10.3m was transferred to the CIOG [Chief Information Officer Group] component of SEA1000 Phase 1B for the Defence Secret Environment – International and equity provided to Australian Naval Infrastructure for the Submarine Construction Yard.

2021

Project scope worth $6.4m was transferred to the CIOG component of SEA1000 Phase 1B for the Defence Secret Environment – International.

MRH90 Helicopters

2018

Transfer to DE&IG [Defence Estate and Infrastructure Group] for Facilities Infrastructure ($20.0m), temporary amenities at 6 Aviation Regiment ($0.2m) and for facility remediation at 5 Aviation Regiment ($0.05m).

2020

Project scope was expanded by $31.5m for Full Flight Mission Simulator.

Light Tactical Fixed Wing

2019

Project scope worth $1.0m was transferred to Defence Science and Technology Group for the provision of ongoing contractor technical support for the Structural Substantiation Program.

JORN Upgrade

2020

Project scope worth $2.5m was transferred in from Estate and Infrastructure Group (E&IG) to support AIR2025 Phase 6, which included replacing a facility at the Radar 3 Transmit site which is best delivered by the JORN Prime Contractor, as it involves specialist fit-out and coordinated delivery within JORN operational constraints.

Note 1: The transfer for Joint Strike Fighter was reported in Auditor-General Report No.19 2019–20 2018–19 Major Projects Report, paragraphs 1.38-1.39.

Source: 2020–21 Defence PDSSs.

!Part 2. Defence Major Projects Report

Part 2. Defence Major Projects Report is available to download in a separate PDF file, or in the complete report PDF which is available to download at Related documents on this page.

!Part 3. Assurance by the Auditor-General and the Secretary of Defence

.

Independent Assurance Report by the Auditor-General

PRIORITY ASSURANCE REVIEW – SECTION 19A(5) OF THE AUDITOR-GENERAL ACT 1997

Independent Assurance Report

Department of Defence Project Data Summary Sheets

To the President of the Senate
To the Speaker of the House of Representatives

Conclusion

Based on the procedures I have performed and the evidence I have obtained, nothing has come to my attention that causes me to believe that the information in the 21 Project Data Summary Sheets in Part 3 (PDSSs) and the Statement by the Secretary of Defence, excluding the forecast information, has not been prepared in all material respects in accordance with the 2020–21 Major Projects Report Guidelines (the Guidelines), as endorsed by the Joint Committee of Public Accounts and Audit.

The purpose of the Major Projects Report is to report on the performance of selected major Department of Defence (Defence) equipment acquisition projects (Major Projects), since Second Pass Approval, and associated sustainment activities (where applicable), managed by Defence.

I have undertaken a limited assurance review of the PDSSs, reporting on the status of the projects selected by the Joint Committee of Public Accounts and Audit, and the Statement by the Secretary of Defence, for the year-ended 30 June 2021. The following forecast information was excluded from the scope of this engagement:

  1. Section 1.2 Current Status—Materiel Capability Delivery Performance and Section 4.1 Measures of Materiel Capability Delivery Performance;
  2. Section 1.3 Project Context—Major Risks and Issues and Section 5 – Major Risks and Issues; and
  3. forecast dates where included in each PDSS.

The forecast information has not been included in the scope of the engagement, due to the lack of Defence systems from which to provide complete and accurate evidence, in a sufficiently timely manner to facilitate the review. Accordingly, my conclusion does not provide any assurance in relation to this forecast information. However, material inconsistencies identified in relation to the forecast information are required to be considered in forming my conclusion.

Basis for Conclusion

I have undertaken a limited assurance review in accordance with the ANAO Auditing Standards, which include the relevant Standard on Assurance Engagements ASAE 3000 Assurance Engagements Other than Audits or Reviews of Historical Financial Information, issued by the Auditing and Assurance Standards Board.

I believe that the evidence I have obtained is sufficient and appropriate to provide a basis for my conclusion.

Responsibilities of the Secretary of Defence for the Project Data Summary Sheets

The Secretary of Defence is responsible for the preparation and presentation of the PDSSs for the 21 selected projects, and the Statement by the Secretary of Defence, in accordance with the Guidelines. This responsibility includes the design, implementation and maintenance of internal control that the Secretary determines is necessary to enable the preparation of PDSSs that are free from material misstatement, whether due to fraud or error. The Guidelines provide that the PDSSs and supporting evidence, provided to the ANAO for review, are complete and accurate.

Independence and Quality Control

I have complied with the independence and other relevant ethical requirements relating to assurance engagements, and applied Auditing Standard ASQC 1 Quality Control for Firms that Perform Audits and Reviews of Financial Reports and Other Financial Information, Other Assurance Engagements and Related Services Engagements in undertaking this assurance review.

Responsibilities of the Auditor-General

My responsibility is to express an independent limited assurance conclusion on the PDSSs and Statement by the Secretary of Defence, based on the procedures I have performed and the evidence I have obtained. ASAE 3000 requires that I plan and perform my procedures to obtain limited assurance about whether anything has come to my attention that the PDSSs and the Statement by the Secretary of Defence have not, in all material respects, been prepared in accordance with the Guidelines.

In a limited assurance engagement, the assurance practitioner performs procedures, primarily consisting of: making enquiries of managers and others within the entity, as appropriate; the examination of documentation; and the evaluation of the evidence obtained. The procedures selected depend on my judgement, including identifying areas where the risks of material misstatement are likely to arise. The procedures performed are detailed at paragraph 1.7 of Part 1 of this report.

The procedures performed in a limited assurance engagement vary in nature and timing from, and are less in extent than those performed for, a reasonable assurance engagement. Consequently the level of assurance obtained in a limited assurance engagement is substantially lower than the assurance that would have been obtained had a reasonable assurance engagement been performed. Accordingly I do not express a reasonable assurance opinion on whether the PDSSs and the Statement by the Secretary of Defence are prepared in all material respects in accordance with the Guidelines.

Grant Hehir
Auditor-General
Canberra
6 December 2021

Statement by the Secretary of Defence

Statement by the Secretary of Defence

The attached Project Data Summary Sheets (PDSS) for the 21 major projects included in this report have been prepared in accordance with the Guidelines developed by Defence in consultation with the Australian National Audit Office and endorsed by the Joint Committee of Public Accounts and Audit.

Project Status as at 30 June 2021

In my opinion, the Project Data Summary Sheets comply in all material respects with the Guidelines and reflect the status of the projects as at 30 June 2021.

Significant Events Occurring Post 30 June 2021

In stating this opinion that the PDSSs comply in all material respects with the Guidelines, I acknowledge the following material events have occurred post 30 June 2021:

AIR6000 Phase 2A/2B – Joint Strike Fighter

Australian F-35A aircraft A35-041 was accepted on 1 July 2021. The aircraft was ferried with A35-038, -039 and -040, which were accepted in June 2021, to Eielson Air Force Base in Alaska to participate in the United States - led Exercise Red Flag 2021.

SEA5000 Phase 1 – Future Frigates

In July 2021, the Government announced a delay of up to 18 months to the commencement of construction for the first Hunter class frigate due to design maturity issues experienced in the United Kingdom’s Type 26 Program that are having flow on effects to the Hunter class. Delaying commencement of construction by up to 18 months will provide more time to address design maturity, conduct enhanced prototyping activities and agree appropriate commercial terms for build of the first three ships. This initial schedule delay will be recovered over the life of the program.

The key element of System Definition Review (specifically the Mission System) that will support the functional baseline being struck completed on 1 December 2021. The element of the review dealing with the Support System has been rescheduled from October 2021 to mid-2022. This will not impact on the program entering the construction phase.

SEA1000 Phase 1B – Future Submarines

On 16 September 2021, the Australian Government announced an enhanced security partnership between the United Kingdom, the United States and Australia – AUKUS. Given the changing strategic environment in the Indo-Pacific, the first program to be delivered under the AUKUS arrangement would be nuclear-powered submarines for Australia. The announcement included the Government’s decision to not proceed with the Attack class submarine program. As a result, activities are now focussed on supporting closure of the Program. This decision does not reflect on the progress made by the two prime contractors – Naval Group and Lockheed Martin Australia – in delivering against the contract, with work, supported by the Department, progressing up until 16 September 2021.

AIR9000 Phase 2/4/6 – Multi-Role Helicopter

The MRH90 transmission repair and overhaul facility project reached the Operational Readiness milestones on 5 August 2021 and Leonardo Australia have included the first transmissions to undergo repair / overhaul.

The project was notified on 30 August 2021 of delays to role equipment projects. The cause of these delays are being remediated but will have a flow on effect to the declaration of Final Materiel Release, which is now at risk of being delayed until at least quarter two of 2022. Consequently, declaration of Final Operational Capability will also be further delayed.

SEA1180 Phase 1 – Offshore Patrol Vessel

Construction of the fifth Arafura class offshore patrol vessel (Illawarra) commenced at Henderson in Western Australia on 1 November 2021. The first Arafura class offshore patrol vessel (Arafura) will be launched at Osborne in South Australia on 16 December 2021.

SEA1654 Phase 3 – Supply Class Replenishment Ships

The second Supply class replenishment ship completed fit-out at HMAS Stirling in Western Australia and was accepted by the Department from the prime contractor, Navantia, in August 2021. She was commissioned into Navy service as HMAS Stalwart on 13 November 2021. On 26 October 2021, her sister ship, HMAS Supply, achieved Initial Operational Capability.

JP2072 Phase 2B – Battlespace Communications System

Three medium SATCOM terminals were delivered on 28 July 2021. Release 3 Mission System Field Test was completed on 17 August 2021. The final three terminals arrived at Wacol from the United States (Boeing Defence Australia Testing and Integration Facility) on 23 August 2021.

SEA1442 Phase 4 – Maritime Comms

In September 2021, the third ANZAC ship system (HMAS Warramunga) was accepted and the milestones Mission System Acceptance and Initial Materiel Release were achieved.

SEA1448 Phase 4B – ANZAC Air Search Radar Replacement

Initial Operational Capability was achieved on 1 July 2021.

JP2008 Phase 5A – UHF SATCOM

JP2008 Phase 5A achieved Final Materiel Release for the Network Control System milestone in August 2021 and this was formally recognised by the Capability Manager on 17 September 2021. Subsequently, the project declared interim operational capability in October 2021.

Update on Projects that exited the MPR in 2019-20:

SEA4000 Phase 3 – Hobart Class Air Warfare Destroyers

Final Operational Capability for the Hobart class destroyers was achieved on 25 June 2021 following successful Combat System Ship Qualification Trials by HMAS Sydney in United States waters earlier in the year.

AIR7000 Phase 2 – P-8A Poseidon

AIR7000 Phase 2 continues to plan for the next set of capability updates to the P-8A aircraft, Mission Support Elements and Training Systems ahead of the project’s next major milestone in mid-2022. Delivery of other project elements including remaining spares and the UNIPAC III Search and Rescue kit continued.

AIR5349 Phase 3 – Growler

AIR5349 Phase 3 is on schedule to achieve Final Materiel Release mid-2022 within the approved budget. Materiel Release 5 milestone is scheduled to be achieved at the end of quarter three in 2021. Materiel Release milestones 4, 6 and 8 have been rescheduled to May 2022, preceding Final Materiel Release.

SEA1439 Phase 3 – Collins Class Submarine Reliability and Sustainability

The installation of planned engineering enhancements to HMA Ships Collins, Sheenan and Rankin has been completed. Installation in HMA Ships Farncomb and Dechaineux has commenced and is expected to be completed by January 2022 and June 2022 respectively. Final Operational Capability remains on track for achievement in 2023.

LAND53 Phase 1BR – Night Fighting Equipment Replacement

The project has completed Materiel Releases 1-5, which replaced the Ninox and legacy night fighting equipment nationally. Tranche 2, Gate 2 approval was received in October 2020, and contracts for Fused Night Vision Systems were signed with Missions Systems Australia Pty Ltd (now L3 Harris Integrated Mission Systems Australia Pty Ltd) in December 2020. MAA 2.4 was signed 31 August and includes new Materiel Releases (6-9 inclusive) to ensure Tranche 2 equipment is delivered before September 2023.

JP9000 Phase 7 – Helicopter Aircrew Training System

Chief of Navy declared Final Operational Capability for JP9000 Phase 7 in February 2021.

AIR9000 Phase 8 – MH-60R Seahawk

Since exiting the Major Projects Report in the past 12 months, AIR9000 Phase 8 has completed further ship modification works in the ANZAC Class FFH fleet. Project milestones continue to be met, including the delivery of associated weapons systems and the final MH-60R training device.

JP2048 Phase 4A/4B – Amphibious Ships

Final Operational Capability was declared on 4 November 2019 with notable deficiencies that are being rectified. The table below provides further detail on the deficiencies.

Description of Deficiency

Status

Propulsion Pod Induced Vibration

The propulsion pods exhibited some deficiencies.

Rectification work occurred by upgrading the propulsion pods during the 2020-21 docking schedule. Sea trials with upgraded pods in progress.

PCRF Bed Configuration - Insufficient

The remediation is assigned to Project JP2048 Phase 6.

Excessive Noise in Accommodation Compartments

The remediation is assigned to Project JP2048 Phase 6.

Integrated Logistic Support

Immediate remediation complete. Agreement reached with Designer (Navantia Australia Pty Ltd) on the scope of the Engineering Change Proposals (ECP).

Magazine Capacity

Deficiencies were partially remediated to HMAS Adelaide during 2021 docking. Scheduled works to HMAS Canberra were deferred due to COVID-19 travel restrictions and competing priorities during 2020-21.

Sewage Treatment Plants (STP)

The system experienced some deficiencies.

Defence planned to remediate one STP during HMAS Adelaide’s docking schedule in 2021. Once the proposed solution has been installed and assessed as effective, Defence will undertake remediation of the remaining three STPs on an opportunity basis. However, the remediation effort was impacted by COVID-19 travel restrictions. Defence is currently undergoing discussions with prime contractors to revise the remediation schedule.

COVID-19 Impact Statement

The impact on Defence contracts as a result of the COVID-19 pandemic has continued to be felt in the 2020-21 reporting year. Schedule delays to projects can be largely attributed to the effects of supply disruption, national and international travel restrictions and city and state mandated lockdowns. Project Teams that were heavily impacted by the pandemic have worked to develop and administer COVID-19 Recovery Deeds where needed.

Greg Moriarty
Secretary
Department of Defence
02 December 2021

!Part 4. JCPAA 2020–21 Major Projects Report Guidelines

The JCPAA 2020–21 Major Projects Report Guidelines part is available to download in a separate PDF file, or in the complete report PDF which is available to download at Related documents on this page.

Footnotes

1 Department of Defence, Defence Annual Report 2020–21, Defence, Canberra, 2021, Chapter 3, Annual Performance Statements, 2021, p.38.

2 Department of Defence, Defence Portfolio Budget Statements 2020–21, Defence, Canberra, 2020, p.22.

3 Department of Defence, Defence Annual Report 2020–21, Defence, Canberra, 2021, Appendix A Financial Statements, Note 3.2A, p.202.

4 The 2020–21 Major Projects Report Guidelines were endorsed by the JCPAA in November 2020 and are included in Part 4 of this report.

5 Joint Committee of Public Accounts and Audit, Parliament of the Commonwealth of Australia, Report 483: Inquiry into the 2018–19 Defence Major Projects Report and the Future Submarine Project – Transition to Design (Auditor-General’s Reports 19 and 22 (2019–20)), (2020), Objective of the Major Projects Report, p.6.

6 The JCPAA has taken an active role in the development and review of the MPR program. The main changes to the MPR Guidelines have tended to follow on from the JCPAA’s recommendations.

7 In a limited assurance engagement, the assurance practitioner (in this case the ANAO) performs procedures, primarily consisting of: making enquiries of managers and others within the entity, as appropriate; the examination of documentation; and the evaluation of the evidence obtained. The procedures performed are detailed in paragraphs 1.7 to 1.9 of Part 1 of this report. The procedures performed in a limited assurance engagement vary in nature and timing from, and are less in extent than those performed for, a reasonable assurance engagement (an ANAO performance audit is typically a reasonable assurance engagement). Consequently, the level of assurance obtained in a limited assurance engagement is substantially lower than the assurance that would have been obtained had a reasonable assurance engagement been performed.

8 Section 1.2 Current Status—Materiel Capability Delivery Performance; Section 1.3 Project Context—Major Risks and Issues; Section 4.1—Measures of Materiel Capability Delivery Performance; Section 5—Major Risks and Issues; and forecast dates included in a PDSS.

9 For example, Defence project risk management records can be managed in spreadsheets, where the risk to the completeness and accuracy of records is too high to be included within the scope of the review.

10 Joint Committee of Public Accounts and Audit, Parliament of the Commonwealth of Australia, Report 473: Defence Major Projects Report (2016–17), (2018), Recommendation 2, p.vii.

11 The 2020–21 MPR Guidelines also require Defence to report, in the Statement by the Secretary of Defence, on projects which have been removed from the MPR which still have outstanding caveats, significant remaining materiel capability or milestones to be delivered. Defence has reported updates for AWD Ships, P-8A Poseidon, Growler, MH-60R Seahawk, LHD Ships, HATS, Night Fighting Equip Repl and Collins R&S.

12 Joint Committee of Public Accounts and Audit, Parliament of the Commonwealth of Australia, Report 442: Inquiry into the 2012–13 Defence Materiel Organisation Major Projects Report, (2014), pp.37–39.

Joint Committee of Public Accounts and Audit, Parliament of the Commonwealth of Australia, Report 458: Defence Major Projects Report (2014–15), (2016), pp.48–49.

13 Joint Committee of Public Accounts and Audit, Parliament of the Commonwealth of Australia, Report 473: Defence Major Projects Report (2016–17), (2018), List of Recommendations, p.vii.

14 Department of Defence, written supplementary submission 7 to the Joint Committee of Public Accounts and Audit, Inquiry into the 2018–19 Major Projects Report and Future Submarines Project – Transition to Design, p.11.

15 The reporting of cost variations was also raised at the JCPAA’s public hearing into the 2016–17 MPR on 23 March 2018 and at estimates hearings of the Finance and Public Administration Legislation Committee on 27 February 2018.

16 Auditor-General Report No.34 2020–21, Implementation of ANAO and Parliamentary Committee Recommendations – Department of Defence, (2021), Table 3.3.

17 Auditor-General Report No.34 2020–21, Implementation of ANAO and Parliamentary Committee Recommendations – Department of Defence, (2021). Table 3.3 contained information on the implementation of Recommendations 1 and 2 of Auditor-General Report No.31 2018–19 Defence’s Management of its Projects of Concern.

18 Auditor-General Report No.19 of 2019–20 Major Projects Report, 2020 p.23.

19 Auditor-General Report No.34 of 2020–21, Implementation of ANAO and Parliamentary Committee Recommendations – Department of Defence, (2021), Table 3.3 [Recommendation 1 of Auditor-General Report No.3 of 2019–20 Defence’s Quarterly Performance Report on Acquisition and Sustainment].

20 ibid, Table 3.3 [Recommendation 1 of Auditor-General Report No.40 of 2018–19 Modernising Army Command and Control — the Land 200 Program].

21 Independent Assurance Reviews were not conducted for: Joint Strike Fighter, Future Subs, Hawkei, JORN Upgrade, Maritime Comms, and UHF SATCOM.

22 The individual PDSSs also report on budget variations.

23 The JCPAA requested in May 2018 that the ANAO report back to the Committee on how Defence Major Projects cost variations and the costs of retaining project staff over time might be reported in future MPRs. See paragraphs 1.64 to 1.67 for the outcomes of this consideration.

24 Slippage refers to a delay in the current forecast date compared to the original government approved date of Final Operational Capability (FOC). These figures exclude delays to a project’s schedule that do not result in slippage past the original government approved date, and schedule reductions over the life of the project.

25 Future Frigates and Future Subs are excluded as these projects did not have FOC milestones approved by government at 30 June 2021. Refer to the Statement by the Secretary of Defence for further details on these projects.

26 Future Frigates and Future Subs are excluded from this analysis as they did not have FOC milestones approved by government at 30 June 2021.

27 Hornet Refurb and BMS are excluded from this analysis as they did not have FOC milestones approved by government.

28 Off-The-Shelf: systems, hardware or software that already exists or is confirmed in service for an equivalent purpose and requires no, or minimal change. Sometimes expressed as commercial off-the-shelf or military off-the-shelf. Department of Defence, Defence Test and Evaluation Policy, Defence, Canberra, 2019, Annex 1A, Definitions, p.ii.

29 Joint Committee of Public Accounts and Audit, Parliament of the Commonwealth of Australia, Report 442: Inquiry into the 2012–13 Defence Materiel Organisation Major Projects Report, (2014), Recommendation 5, p.31.

30 Defence projects are graded into one of four acquisition categories (ACATs) on the basis of project complexity. The complexity of a project may vary over its life cycle. See paragraph 2.23.

31 ACAT I – These are major capital equipment acquisitions that are normally the ADF’s most strategically significant. They are characterised by extensive project and schedule management complexity and very high levels of technical difficulty, operating, support and commercial arrangements.

32 ACAT II – These are major capital equipment acquisitions that are strategically significant. They are characterised by significant project and schedule management and high levels of technical difficulty, operating, support arrangements and commercial arrangements.

33 The previous project name was Battlefield Airlifter.

34 Further information on COVID-19 impacts is reported in the Statement by the Secretary of Defence.

35 For example, Joint Committee of Public Accounts and Audit, Parliament of the Commonwealth of Australia, Report 473: Defence Major Projects Report (2016–17), (2018), Recommendation 2, p.vii, which recommended transitioning to risk registers with better version control measures than spreadsheets. Defence has mandated the risk management tool Predict! for all projects in this report, the implementation of which is discussed at paragraph 1.71.

36 Department of Defence, Independent Assurance Reviews for Programs, Projects and Products, Defence, Canberra, 2020, pp.5 and 12.

37 Although referred to by Defence as ‘assurance’ reviews, these administrative reviews are not carried out within frameworks issued by the Australian Auditing and Assurance Standards Board.

38 Department of Defence, Independent Assurance Reviews for Programs, Projects and Products, Defence, Canberra, 2020.

39 IARs were not conducted for: Future Subs, Overlander Medium/Heavy, Hawkei, JORN Upgrade, Maritime Comms, and UHF SATCOM.

40 Department of Defence, Defence Annual Report 2020–21, Chapter 7, Asset Management, Defence, Canberra, 2021, p.153.

41 Issues in the project were discussed in Auditor-General Report No.52 2013–14, Multi-Role Helicopter Program.

42 See the MRH90 Helicopters PDSS in Part 3 of this report.

43 A Greene, Australia to buy $1.3 billion fleet of US-made choppers as navy dumps troubled European-made MRH-90 Taipans – [internet], ABC News, available from https://www.abc.net.au/news/2021-10-09/us-to-sell-12-attack-helicopters-to-australia-aukus-/100526744 [accessed 22 October 2021]. Media reports were based on an 8 October 2021 announcement by the United States Defense Security Cooperation Agency that ‘The State Department has made a determination approving a possible Foreign Military Sale to the Government of Australia of MH-60R Multi-Mission Helicopters, Related Defense Services, and related equipment for an estimated cost of $985 million. The Defense Security Cooperation Agency delivered the required certification notifying Congress of this possible sale today.’ Media release, Washington, 8 October 2021 [internet], available from https://www.dsca.mil/press[1]media/major-arms-sales/australia-mh-60r-multi-mission-helicopters-and-related-defense [accessed 28 November 2021].

44 Auditor-General Report No.31 2018–19 Defence’s Management of its Projects of Concern, p.10.

45 This advice was reported in Auditor-General Report No.19 2020–21 2019–20 Major Projects Report, paragraph 1.16.

46 Auditor-General Report No.34 2020–21 Implementation of ANAO and Parliamentary Committee Recommendations — Department of Defence, p.7.

47 Committee Hansard, JCPAA inquiry into Auditor-General’s report No.19 (2020–21) Defence Major Projects Report 2019 - 20, [internet] p.13. Available from: https://parlinfo.aph.gov.au/parlInfo/search/display/display.w3p;query=Id%3A%22committees%2Fcommjnt%2F473b6942-9139-484d-bd6b-02778e98efc5%2F0000%22 [accessed 29 November 2021].

48 Auditor-General Report No.19 2020–21 2019–20 Major Projects Report, p.166.

49 S Morrison (Prime Minister), ‘Australia to pursue nuclear-powered submarines through new trilateral enhanced security partnership’ media statement, Parliament House, Canberra, 16 September 2021.

50 Department of Defence, Quarterly Performance Report June 2020, Defence, Canberra, 2020, p.5.

51 Auditor-General Report No.3 2019–20 Defence’s Quarterly Performance Report on Acquisition and Sustainment, p.7.

52 ibid, pp.7-8.

53 ibid, p.7.

54 Auditor-General Report No.19 2018–19 2019–20 Major Projects Report, paragraphs 1.20–1.21, p.23.

55 In Auditor-General Report No.34 2020–21 Implementation of ANAO and Parliamentary Committee Recommendations — Department of Defence, Recommendation 1 relating to the use of the QPR was assessed as: implementation was completed in line with the intent of the recommendation.

56 Similar to the approach adopted for PDSSs, the PSR provides a summary of projects’ performance in the areas of cost, schedule and capability. However, there are some differences between the measures used and the level of detail provided. For example, both the PDSSs and the PSR use a ‘traffic light indicator’ to reflect materiel capability delivery/scope, but the indicators are defined differently for the two products. In the PDSSs, ‘Amber’ materiel capability delivery is defined as ‘under threat but still considered able to be met’, whereas the PSR defines ‘Amber’ materiel capability delivery/scope as ‘major elements of scope are about to fail against the baseline’. In addition, the PSR allows for only one indicator to be used in the assessment — that is, ‘all Green’, ‘all Amber’ or ‘all Red’. In contrast, the Pie Chart in the PDSSs allows for a breakdown of capability, with individual components assessed as Green, Amber or Red, providing a more detailed assessment.

57 Commonwealth, Budget Estimates, Foreign Affairs, Defence and Trade, 1 June 2021, Mr T Fraser, Deputy Secretary, Capability Acquisition and Sustainment Group, Department of Defence, p.151.

58 These are CASG acquisition projects that have variances significant enough — in the areas of schedule, cost, and/or capability performance — to warrant attention from senior management. Department of Defence, Project and Sustainment Report February 2021, Defence, Canberra, 2021, p.39.

59 Department of Defence, Project and Sustainment Report February 2021, Defence, Canberra, 2021, p.47.

60 ibid, p.40.

61 ibid, p.63.

62 ibid, p.49.

63 Previously known as Battlefield Airlifter.

64 Department of Defence, Project and Sustainment Report February 2021, Defence, Canberra, 2021, p.65.

65 ibid, p.61.

66 ibid, p.45.

67 ibid, p.47.

68 Ibid, p.53.

69 In the March 2019 QPR, the entire JP2008 program was identified as a Program of Interest, which is inclusive of UHF SATCOM. Department of Defence, Quarterly Performance Report March 2019, Defence, Canberra, 2019, p.27.

70 The FOC dates for these projects slipped in-year by: 24 months for MQ-‍4C Triton, 18 months for Light Tactical Fixed Wing, and 13 months for CMATS. See Table 3.

71 Department of Defence, Interim Capability Life Cycle Manual, Defence, Canberra, 2017, pp.14 and 93.

72 The Project Directive defines the project, in terms of fundamental inputs to capability, together with the resources necessary to deliver the project, and is developed in accordance with the parameters agreed by government. Department of Defence, Interim Capability Life Cycle Manual, Defence, Canberra, 2017, p.93.

73 The Defence Capability Manual (Version 1.0) does not describe MAAs and instead refers to Product Delivery Agreements (PDAs) (see paragraph 1.42). Projects in this MPR have an approved MAA.

74 Department of Defence, Interim Capability Life Cycle Manual, Defence, Canberra, 2017, p.14 and p.93.

75 Auditor-General Report No.6 2013–14 Capability Development Reform, paragraph 11.54.

76 Auditor-General Report No.40 2016–17 2015–16 Major Projects Report, paragraph 1.21.

77 A PDA is an agreement between the Sponsor and Lead Delivery Group which specifies the scope, resourcing, priorities and performance and preparedness requirements for support of a capability system throughout its life, to support performance measurement. Department of Defence, Defence Capability Manual, Defence, Canberra, 2020, p.49.

78 Department of Defence, (PM) 003, CASG Project Controls Manual, Acronyms, Abbreviations and Definitions, 2017, p.8.

79 Joint Committee of Public Accounts and Audit, Parliament of the Commonwealth of Australia, Report 436: Review of the 2011–12 Defence Materiel Organisation Major Projects Report, (2013), paragraph 3.4, p.14.

80 Auditor-General Report No.19 2019–20 2018–19 Major Projects Report, p.26.

81 Department of Defence, Management of Contingency Budgets in Defence Acquisition Projects, Defence, Canberra, 2019, p.2.

82 ibid, p.3.

83 ibid, p.4.

84 The reporting of cost variations was also raised at the JCPAA’s public hearing into the 2016–17 MPR on 23 March 2018 and at estimates hearings of the Finance and Public Administration Legislation Committee on 27 February 2018.

85 See paragraph 1.3 for more information.

86 Predict! is a risk management tool used by Defence to manage risks and issues.

87 The CASG Project Risk Management Manual version 2.5, Business Rule 2 requires the project manager to validate the currency of the Risk Management Plan on transition from one stage of the Capability Life Cycle to the next stage and, for any stage that is longer than six months, every six months within that stage.

88 As at 30 June 2021, Defence risk management guidance for acquisition projects was the PM 002 CASG Project Risk Management Manual (PRMM), Version 2.5 2019. Guidance for sustainment products was the DMM (LOG) 04-0-003, Defence Materiel Manual (Logistics Management), which provides different consequence and likelihood descriptors. Since 30 June 2021, for projects that are managing risk in Predict! version 6, acquisition and sustainment risk management are both guided by the (CP) 005 Capability Acquisition and Sustainment Risk Management Manual, Version 1.0 2021.

89 Joint Committee of Public Accounts and Audit, Parliament of the Commonwealth of Australia, Report 473: Defence Major Projects Report (2016–17), (2018), List of Recommendations, p.vii.

90 Department of Defence, written supplementary submission 7 to the Joint Committee of Public Accounts and Audit, Inquiry into the 2018–19 Major Projects Report and Future Submarines Project – Transition to Design, p.11.

91 Defence advised the ANAO in October 2021 that as at 30 June, the seven projects not yet using Predict! were: MRH90 Helicopters, Light Tactical Fixed Wing, CMATS, Battlefield Command System, Battle Comm. Sys. (Land) 2B, Collins Comms and EW, and UHF SATCOM.

92 Department of Defence, PM 006 – Lessons – CASG Lessons Program, Version 2.0, Defence, Canberra, 2020.

93 Auditor-General Report No.20 2018–19, 2017–18 Major Projects Report, paragraphs 1.61–1.62, p.32.

94 A project’s budgeted cost and schedule data is presented as at 30 June 2021, and may differ from originally approved budgets and schedules.

95 Future Frigates and Future Subs are excluded from this analysis as they did not have FOC milestones approved by government at 30 June 2021. JORN Upgrade is excluded as its FOC forecast is disclosed in its PDSS as ‘TBA’.

96 Between First Pass Approval in May 2015 and Second Pass Approval in August 2017, government approved $65.6 million of funding to undertake these activities.

97 Prior to 1 July 2010, projects were periodically supplemented for price indexation, whereas the allocation for price indexation is now provided for on an out-turned basis at Second Pass Approval.

98 Australian Government arrangements for foreign exchange variation involve ‘no win/no loss’ supplementation. As a matter of policy, unless specifically approved, individual entities are not permitted to ‘hedge’ against foreign exchange risk.

99 Real Variations include ‘Scope’ changes attributable to changes in requirements by Defence and government; ‘Transfers’ which occur when a portion of the budget and corresponding scope is transferred to or from another approved project or sustainment product in Defence; ‘Budgetary Adjustments’ made to account for corrections resulting from foreign exchange or indexation accounting estimation errors; ‘Real Cost Increases’, where funds have been approved by government to increase the project budget (generally without a change in scope); and ‘Real Cost Decreases’, where funds have been handed back to the Defence portfolio.

100 See Table 3, on p.13, of this report.

101 Extensions to planned withdrawal dates may involve additional costs relating to the maintenance and servicing of equipment.

102 Refer to paragraph 34, on p.14, for a discussion of definitions for these different acquisition types.

103 The Defence Procurement Review 2003, also known as the Kinnaird Review, observed that off-the-shelf equipment can usually be delivered faster than equipment requiring development, and proposed that off-the-shelf alternatives must be one of the options put to government when seeking approval to procure a capability. See M Kinnaird, Defence Procurement Review 2003, Department of Defence, Canberra, 2003.

104 The 2015 First Principles Review identified technical risk as the major cause of post Second Pass Approval schedule slippage, and observed that schedule slippage causes cost escalation. See D Peever, First Principles Review: Creating One Defence, Department of Defence, Canberra, 2015, p.34 and p.92. Defence’s implementation of the First Principles Review was examined in Auditor-General Report No.34 2017–18 Defence’s Implementation of the First Principles Review.

105 These Defence definitions were included in Auditor-General Report No.19 2020–21 2019–20 Major Projects Report, at p.104.

106 Discussed in footnote 103.

107 Auditor-General Report No.19 2019–20 2018–19 Major Projects Report, paragraph 2.27.

108 Slippage refers to a delay in the current forecast date compared to the original government approved date of Final Operational Capability (FOC).

109 Future Frigates and Future Subs are excluded from this analysis as they did not have FOC dates approved by government at 30 June 2021.

110 Hornet Refurb and BMS are excluded as they did not have FOC dates approved by government.

111 Wedgetail project.

112 Collins RCS project.

113 Of the two projects added to the MPR in 2020–21, one is developmental (JORN Upgrade).

114 Collins RCS project.

115 See the Hawkei PDSS in Part 3 of this report.

116 MRH90 Helicopters, CMATS, Battlefield Command System, and Battle Comm. Sys. (Land) 2B.

117 MQ-4C Triton, Light Tactical Fixed Wing, Collins Comms and EW, Pacific Patrol Boat Repl, Maritime Comms, and UHF SATCOM.

118 Slippage refers to a delay in the current forecast date compared to the original government approved date of FOC. These figures exclude delays to a project’s schedule that do not result in slippage past the original government approved date, and schedule reductions over the life of the project.

119 See the Maritime Comms PDSS in Part 3 of this report.

120 Auditor-General Report No.6 2013–14 Capability Development Reform, paragraphs 9.1 to 9.4, pp.198–199.

121 Further information on MRH90 Helicopters can be found in Auditor-General Report No.48 2008–09 Planning and Approval of Defence Major Capital Equipment Projects, pp.84, 90 and 133; Auditor-General Report No.52 2011–12 Gate Reviews for Defence Capital Acquisition Projects, pp.86–87 and pp.130–133; and Auditor-General Report No.52 2013‍–‍14 Multi-Role Helicopter Program.

122 Future Frigates and Future Subs are excluded from this analysis as they did not have FOC milestones approved by government at 30 June 2021. The JORN Upgrade and CMATS projects FOC forecast is disclosed in the PDSS as ‘TBA’. CMATS has disclosed 13 months slippage.

123 In the Statement by the Secretary of Defence in Part 3 of this report, the Secretary also makes reference to additional information on delays, including to Future Frigates and MRH90 Helicopters, and achieved milestone dates for Future Subs, Offshore Patrol Vessel, Repl Replenishment Ships, Maritime Comms, ANZAC Air Search Radar Repl, and UHF SATCOM.

124 Tables 3 and 4, on pp.12 and 13 respectively, report on the slippage for each project that has been in the MPR since 2007–08.

125 Department of Defence, Defence Capability Manual, Defence, Canberra, 2020, p. A-2.

126 ibid, p.12.

127 Future Frigates and Future Subs did not have government approved materiel capability delivery at 30 June 2021 and are therefore excluded from this analysis. The Statement by the Secretary of Defence includes information on delivery of the Future Subs project post 30 June 2021.

128 This project was previously referred to as Battlefield Airlifter.

129 As per the 2020–21 MPR Guidelines, a project is defined as the acquisition or upgrade of Specialist Military Equipment, which normally excludes facilities and other Fundamental Inputs to Capability. The 2020–21 MPR Guidelines also note that the MPR may report on associated sustainment activities (where applicable).

130 Auditor-General Report No.17 2010–11 2009–10 Major Projects Report, p.35.

131 Joint Committee of Public Accounts and Audit, Parliament of the Commonwealth of Australia, Report 442: Inquiry into the 2012–13 Defence Materiel Organisation Major Projects Report, (2014), pp.37–39; and Joint Committee of Public Accounts and Audit, Parliament of the Commonwealth of Australia, Report 458: Defence Major Projects Report (2014–15), (2016), pp.48–49.

132 Joint Committee of Public Accounts and Audit, Parliament of the Commonwealth of Australia, Report 468: Defence Major Projects Report (2015–16), (2017), Recommendation 1, p.vii.

133 Department of Defence, written submission to the Joint Committee of Public Accounts and Audit, Inquiry into the 2016–17 Defence Major Projects Report, p.1.

134 Joint Committee of Public Accounts and Audit, Parliament of the Commonwealth of Australia, Report 473: Defence Major Projects Report (2016–17), (2018), p.2.

135 Commonwealth, Public Hearing, Joint Committee of Public Accounts and Audit, 27 May 2020, Mr T Fraser, Deputy Secretary, Capability Acquisition and Sustainment Group, Department of Defence, p. 3.

136 This approach is not strictly consistent with the intent of MPR Guidelines, which focus on the reporting of transferred scope out of a project without a commensurate transfer of budget. The ANAO will work with Defence to improve clarity of reporting in relation to transfers of scope in the next MPR.
